Introduction
Hold too much inventory and cash sits on a shelf instead of funding growth. Hold too little and a single supplier delay stops a production line or leaves a customer waiting. Many operations leaders struggle with this exact tension every quarter, especially when demand swings faster than replenishment cycles can react.
Supply chain inventory planning and management is the coordinated set of decisions about what inventory you need, where it should sit, when it gets replenished, and how you control it once it arrives. It touches procurement, production, distribution, and finance simultaneously.
This guide breaks down inventory types and the root causes of imbalance, then walks through an end-to-end planning process, decision rules that hold up under real demand swings, and a practical roadmap so improvements stick across functions.
Key Takeaways
- Inventory performance balances service levels, working capital, demand uncertainty, lead times, and operational capacity.
- Planning connects demand, supply, procurement, production, and finance, not just the warehouse.
- Segmentation and reliable data beat applying one policy to every SKU.
- Lasting results require process redesign and workforce adoption, not just new software.
Why Inventory Planning and Management Matter
Planning, Management, and Control Are Different Jobs
Inventory planning sets expected requirements, replenishment timing, target levels, and supply responses. Inventory management coordinates inventory across the whole network — multiple plants, distribution centers, and suppliers. Inventory control handles the accuracy and physical movement of stock inside a specific location. Confusing the three is why so many "inventory projects" fix a warehouse without touching the planning logic that caused the problem.
The Real Cost of Getting It Wrong
Inventory decisions ripple into customer service, production continuity, warehouse capacity, purchasing costs, and cash flow. Excess inventory means:
- Obsolescence and expiry write-offs
- Storage congestion and handling inefficiency
- Cash tied up that could fund other priorities
Insufficient inventory brings the opposite problems:
- Emergency purchasing at premium prices
- Backorders and lost sales
- Production line stoppages
Neither extreme is acceptable. Inventory targets should tie to business strategy and customer commitments, not to an isolated goal of "reduce inventory by X%."

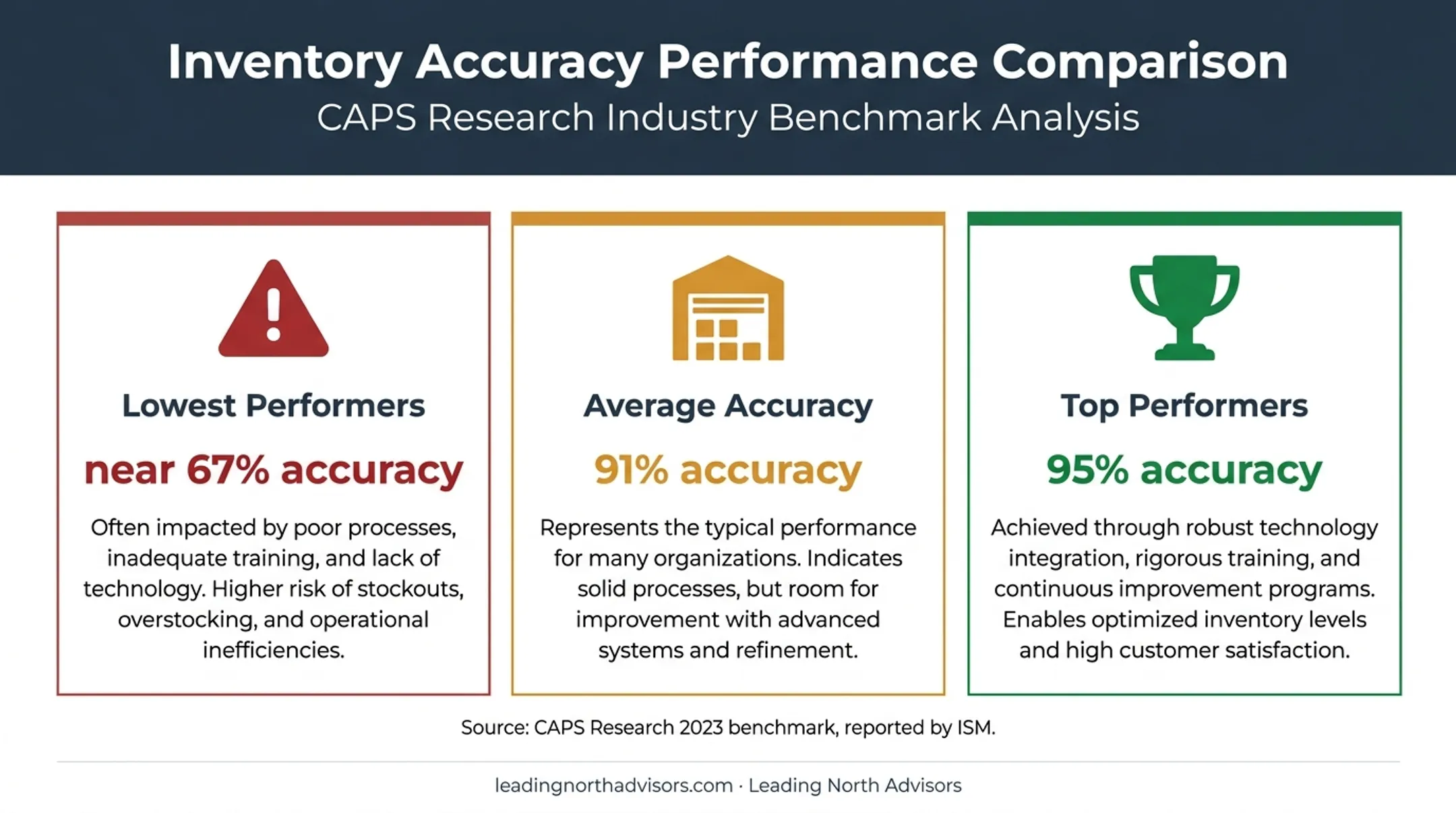

Data accuracy is where most of this breaks down. CAPS Research's 2023 benchmark, reported by ISM, found average inventory accuracy sits at 91%, with the lowest performers near 67% and top performers reaching 95%.

A planning system built on 67%-accurate records will generate confident-looking, wrong replenishment decisions every time.
Inventory Types and Where Risk Hides
Most supply chains carry some mix of:
- Raw materials and components
- Work in progress (WIP)
- Finished goods
- Maintenance, repair, and operations (MRO) supplies
- Cycle stock, safety stock, and transit inventory
- Excess or obsolete inventory
Risk builds up through demand variability, supplier lead-time swings, minimum order quantities, long replenishment cycles, seasonality, and product life-cycle shifts. A multi-site manufacturer that lets one plant hold excess safety stock "just in case," while a sister plant runs short on the same component, isn't managing risk — it's just moving it around the network.
Root Causes That Keep Resurfacing
Recurring inventory problems almost always trace back to:
- Inaccurate item master or bill-of-material data
- Weak or unowned forecasting
- Unclear decision rights between planning and purchasing
- Poor transaction discipline at receiving and issue points
- Siloed decisions made without visibility into other sites
Until those causes are fixed at the planning and management layer, control projects inside a single warehouse will keep treating symptoms.

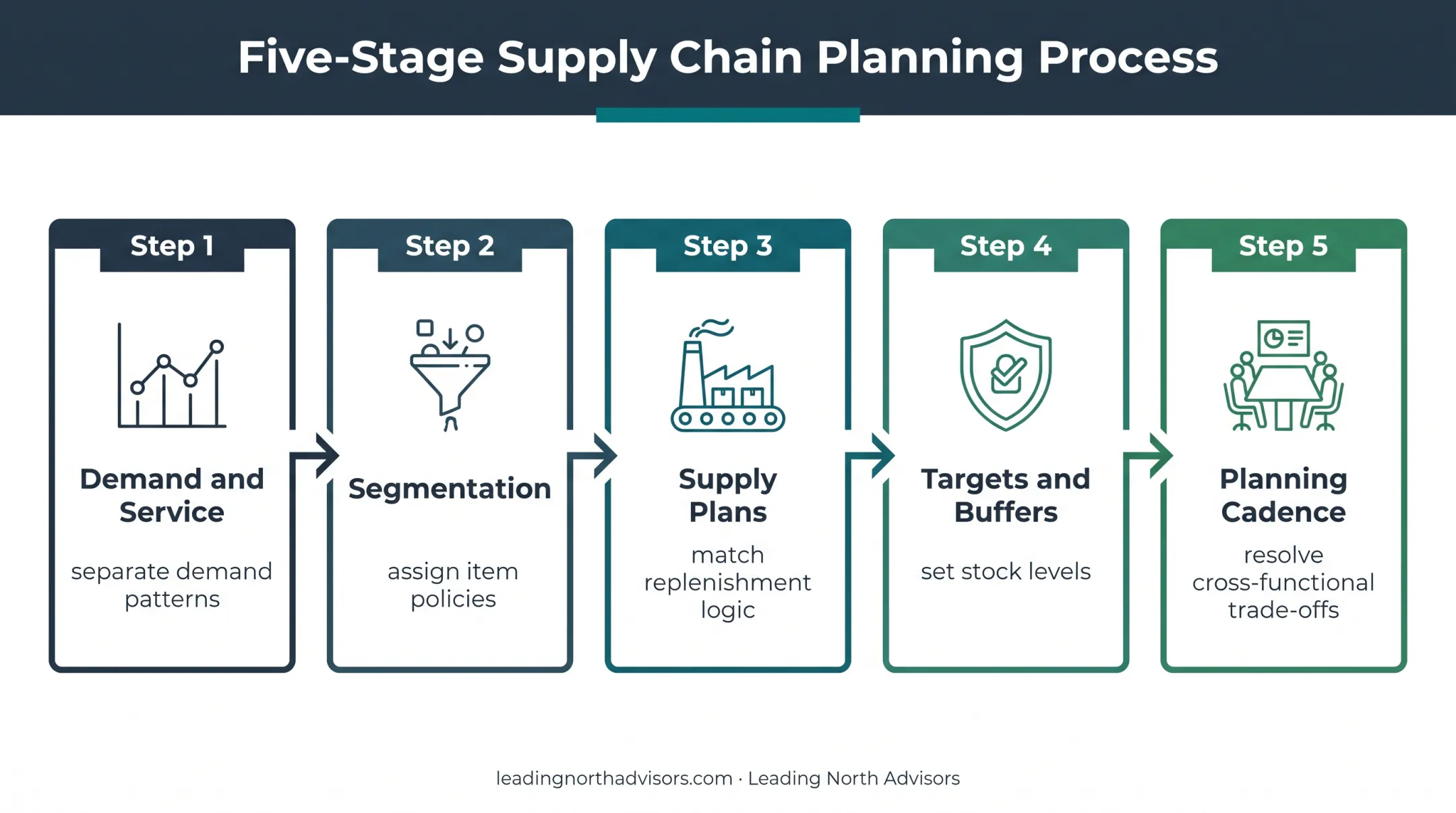

How to Build an End-to-End Inventory Planning Process
Start With Demand and Service Requirements
Define the actual customer, production, clinical, or service-level requirement for each product family. Separate stable demand from seasonal, intermittent, dependent, and highly volatile patterns — they need different treatment. Build the forecast from history plus sales plans, promotions, new-product launches, shutdowns, and external risk factors. Do not rely on history alone.
Segment Before You Set Policy
Not every item deserves the same review frequency or safety stock formula. Use ABC analysis, or ABC/XYZ when you add demand variability, and factor in criticality and lead-time risk, not only dollar value. As ASCM's segmentation guidance explains:
- A items are typically 10-20% of SKUs but 50-70% of dollar volume
- X items are predictable; Z items are irregular and hardest to forecast Assign each segment its own review frequency, approval thresholds, and service target.
Translate Demand Into Supply Plans
Connect forecasts to supplier capacity, production constraints, bills of material, lead times, MOQs, and warehouse capacity. Match each item to the replenishment logic that fits:
- MRP for dependent-demand components tied to a production schedule
- Reorder-point planning for steady, independent-demand items
- Demand-driven replenishment for volatile items whose buffers must flex with actual consumption
Establish Targets and Buffers
Cycle stock covers expected demand between orders. Safety stock absorbs the unexpected. Reorder points and max levels work together to trigger and cap replenishment. Set safety stock from:
- Demand variability and lead-time variability
- Target service level and item criticality
- How fast the organization can respond when something goes wrong
Build a Cross-Functional Planning Cadence
Sales and operations planning (S&OP), or integrated business planning, aligns sales, procurement, manufacturing, logistics, finance, and site leaders around one approved plan instead of six competing spreadsheets. Each cadence cycle should resolve:
- Forecast changes and their downstream impact
- Capacity constraints and supplier risks
- Inventory exceptions that need executive input
- Working-capital trade-offs across sites
- Escalation paths with clear ownership

Inventory Planning Methods and Decision Rules
The 80/20 rule is a useful starting hypothesis for prioritization: a smaller group of items often drives most of the value or activity. It is not, however, a formula that determines every replenishment policy on its own. Validate the split against your own data before building rules around it.
| Method | What It Does | Best Fit |
|---|---|---|
| ABC analysis | Ranks items by usage value | Prioritizing review effort and count frequency |
| Economic order quantity (EOQ) | Calculates optimal order size to balance ordering and holding cost | Stable-demand items with known cost inputs |
| Reorder point | Triggers replenishment at expected demand during lead time plus a buffer | Independent-demand, continuously reviewed items |
| Min-max levels | Sets a floor and ceiling for stock | Stable items needing simple control |
| Periodic review | Replenishes on a fixed schedule | Batched ordering or counting cycles |
| Demand-driven replenishment | Uses dynamic buffers at decoupling points | Variable, multi-echelon environments |
Reorder points are set as expected demand during lead time plus a buffer for variability. That formula only works, though, if the lead-time and demand data feeding it are trustworthy. Unreliable inputs produce a precise-looking number that's simply wrong.
Every method also involves a trade-off between order frequency, ordering or setup cost, transportation cost, supplier minimums, and carrying cost. Ordering more often lowers average inventory but raises transaction and freight costs; ordering less often does the reverse.
Handling Special Situations
Some categories need policy exceptions:
- New products: start with judgment-based forecasts, tighten as sales data accumulates
- End-of-life items: shift to demand-driven drawdown, stop standard replenishment
- Seasonal and perishable goods: build time-boxed buffers, avoid year-round safety stock
- Critical spares: prioritize availability over carrying cost
- Dependent-demand components: plan against the production schedule, not a standalone forecast
Plan for Disruption Scenarios
Test inventory and service implications against realistic scenarios: supplier delays, sudden demand surges, quality holds, transportation interruptions, tariff changes, facility outages, or an abrupt shift in customer mix. Running these as tabletop exercises before they happen is far cheaper than reacting live.
Technology, Governance, and Performance Measurement
Technology Amplifies Existing Discipline
ERP, warehouse management systems, planning tools, inventory visibility platforms, barcode/RFID, and control towers all add real value. None of them correct inaccurate master data or a broken forecasting process on their own. Technology amplifies whatever discipline already exists underneath it.
The Minimum Data Foundation
Reliable planning depends on:
- Item masters and bills of material
- Supplier lead times and order policies
- Units of measure and location data
- Current inventory status and demand history
- Recent cycle-count results
Governance and a Balanced KPI Set
Governance keeps planners from making judgment calls differently. Document at minimum:
- Policies and decision rights
- Exception thresholds and approval rules
- Named ownership of master data
A balanced KPI set should cover service and inventory health:
- Service level or fill rate
- Stockout frequency
- Inventory accuracy
- Days or turns of inventory
- Obsolete inventory value
It should also track planning and supply execution:
- Forecast accuracy
- Supplier lead-time reliability
- Warehouse capacity utilization
Review these by segment and location, not just as one enterprise-wide average. A healthy overall turns number can easily hide a critical-item shortage at one plant and excess stock sitting idle at another.
Implementing and Sustaining Inventory Improvements
Start With a Diagnostic Baseline
Map the flow from demand signal through purchasing, production, storage, and delivery. Quantify current service, inventory, accuracy, lead-time, and obsolescence performance using validated data — not assumptions from last year's budget review.
Prioritize a Focused Portfolio
Pick the product families, facilities, or process steps with the highest financial exposure and customer risk first. Use root-cause analysis to separate a planning-policy problem (wrong reorder point) from an execution problem (inaccurate counts, receiving delays, unapproved substitutions). They need different fixes.
Pilot, Then Standardize
Test revised planning parameters and warehouse standard work in one controlled area before rolling out network-wide. Define leading and lagging measures, review results on a set cadence, and document what conditions are required to replicate results elsewhere.
Build Adoption, Not Just a New Policy
Sustainable inventory improvement depends on people using the new process consistently. Clarify responsibilities across planners, buyers, production, warehouse teams, and suppliers, and reinforce new behaviors in actual performance reviews.
This is where Leading North Advisors typically partners with client teams, working inside the organization through its True North Delivery® model across four stages: Diagnose, Design, Implement, and Sustain. Past client engagements have reported a 50-70% reduction in excess inventory, though results vary by starting point and scope.
Lean methods help teams lock in those stages on the floor:
- Value-stream mapping exposes where material and information actually get stuck
- Standard work reduces variability and clarifies ownership
- Visual management and daily huddles (the backbone of Managing for Daily Improvement) catch problems before they compound
- Structured problem solving addresses root cause instead of symptoms

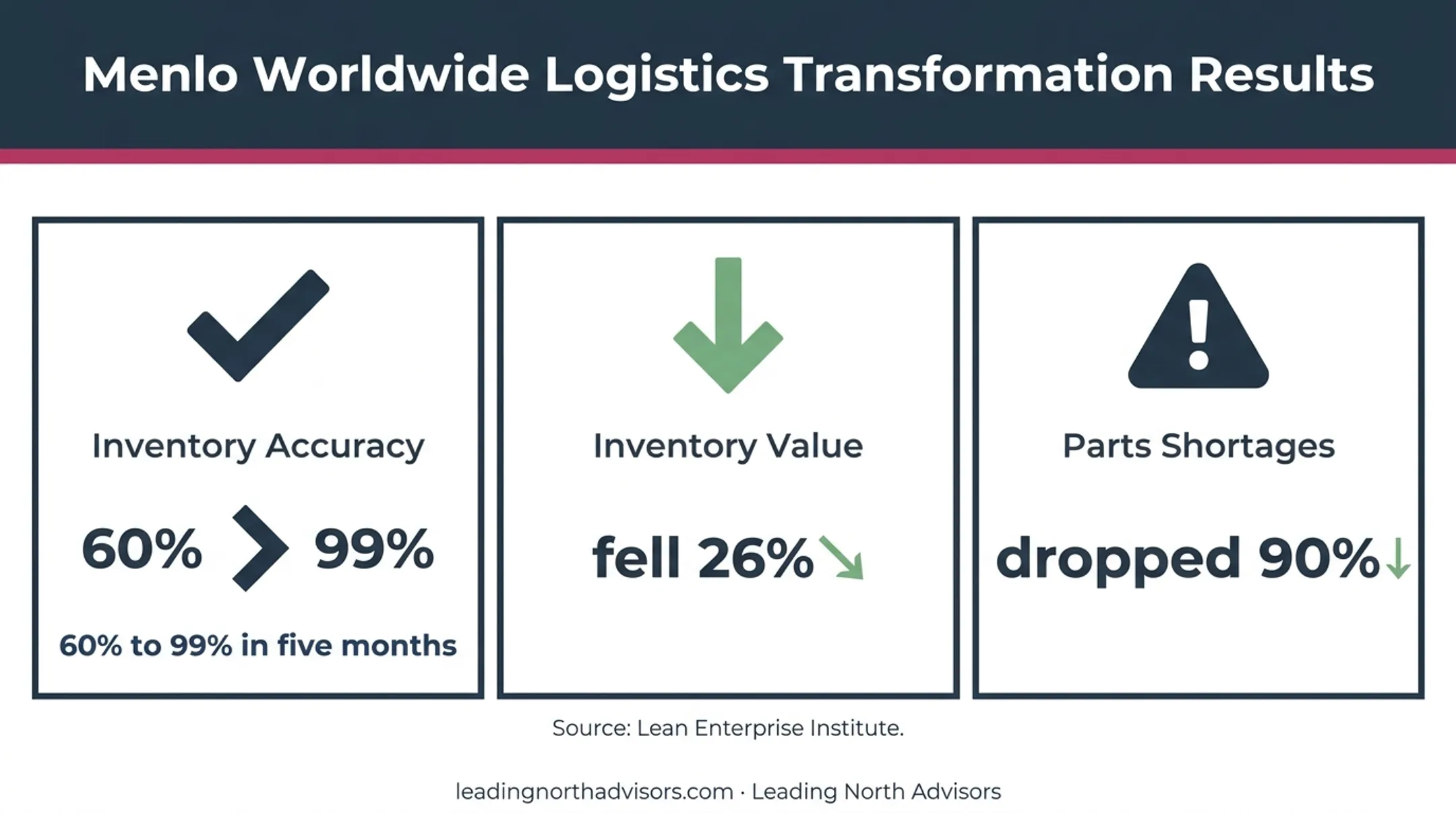

The Lean Enterprise Institute's Menlo Worldwide Logistics case illustrates the scale of what's possible: after applying value-stream mapping, kaizen, 5S, and standard work, inventory accuracy rose from 60% to 99% in five months, inventory value fell 26%, and parts shortages dropped 90%.

A Practical Improvement Sequence
| Phase | Focus |
|---|---|
| Days 1-30 | Baseline data, segmentation review, quick-win identification |
| Days 31-60 | Pilot revised policies and standard work in one area |
| Days 61-90 | Measure results, adjust, prepare for wider rollout |
Timeframes should flex based on your organization's size, data maturity, and change capacity — but most engagements start showing measurable improvement within that first 60-90 day window.
Frequently Asked Questions
What is inventory planning in supply chain?
Inventory planning is the process of determining inventory requirements, replenishment timing, target locations and quantities, and safety buffers across the supply chain. It balances demand, service commitments, cost, and risk.
What is the 80/20 rule in inventory?
The 80/20 rule, or Pareto principle, suggests a smaller group of high-value or high-activity items drives most of the total value or usage. It's a useful prioritization tool, but the actual split should be validated against your company's own data.
How is inventory planning different from inventory management?
Planning sets forward-looking assumptions, targets, and replenishment policies. Management is the ongoing execution: coordinating, monitoring, replenishing, and controlling inventory across the network day to day.
How do companies calculate safety stock?
Safety stock calculations factor in demand variability, lead-time variability, target service level, and item criticality. Accurate, current data matters more than the formula itself — a good formula with bad inputs still produces the wrong number.
What are the most important inventory management KPIs?
Core KPIs include service level or fill rate, stockout frequency, inventory accuracy, inventory turns or days on hand, forecast accuracy, obsolete inventory value, and supplier performance. Standardize definitions across sites before comparing results.
