Integrated Supply Chain: Solutions Procurement orders based on last quarter's forecast. Production schedules around machine availability, not customer demand. Inventory teams stockpile "just in case" while logistics scrambles to expedite shipments nobody planned for. Sound familiar?

When supply chain functions operate as disconnected departments, small local decisions create expensive system-wide problems. A purchasing decision that saves 2% on unit cost can trigger a production delay that costs far more in expedited freight and missed deliveries.

An integrated supply chain fixes this by connecting people, processes, information, and partners around shared operational goals instead of siloed department metrics. In McKinsey's 2024 Supply Chain Risk Survey, 90% of the 88 senior supply chain executives surveyed said they'd faced a disruption that year, yet only 60% had full visibility into their tier-one suppliers.

This article covers what integration actually means, its core components, real benefits and trade-offs, and a practical implementation path grounded in Lean transformation and change management.

Key Takeaways

  • Integration covers coordinated planning, execution, visibility, and improvement from suppliers through delivery
  • Aligned processes, reliable data, and cross-functional accountability matter more than buying new tools
  • Strongest results balance efficiency, service, inventory, cost, and resilience—not one department’s scorecard
  • Phased rollouts with leadership alignment and clear KPIs beat organization-wide “big bang” launches

What Is an Integrated Supply Chain?

An integrated supply chain connects sourcing, procurement, production, inventory, warehousing, transportation, suppliers, and customer demand into one operating system. Instead of each function chasing its own metrics, teams share information, align decisions, and manage trade-offs together.

That's different from basic coordination. Coordination might mean two departments occasionally talk to each other. Integration means they use common performance goals, escalate issues quickly, and make decisions with the whole system in mind — not just their own function.

Integration Doesn't Mean Ownership

Here's a common misconception worth clearing up: supply chain integration is not the same as vertical integration. You don't need to acquire your suppliers or merge with a distributor to run an integrated supply chain.

Integration can involve:

  • Technology that connects planning, execution, and visibility data
  • Process redesign across functions and sites
  • Supplier collaboration built on shared forecasts and performance data
  • Standardized workflows with governance to keep them consistent

A traditional, siloed supply chain looks different in practice. It typically shows up as:

  • Duplicated purchasing across plants
  • Inconsistent inventory policies from site to site
  • Forecasts that conflict between sales and operations
  • Local fixes that create downstream costs nobody traces back to the source

Integration replaces those patterns with shared visibility and aligned decision-making, while leaving ownership structures untouched.

What Are the Core Components of an Integrated Supply Chain?

Integration comes down to five interlocking components that reinforce each other.

Integrated Planning and Decision-Making

Demand, capacity, procurement, production, inventory, and distribution planning should inform each other, not run as separate spreadsheets built by different departments. When a demand planner sees a spike, procurement and production need that signal immediately, not next month.

A shared planning cadence, such as a weekly sales-and-operations meeting, gives leaders a forum to spot constraints early and align decisions with actual customer priorities instead of departmental convenience.

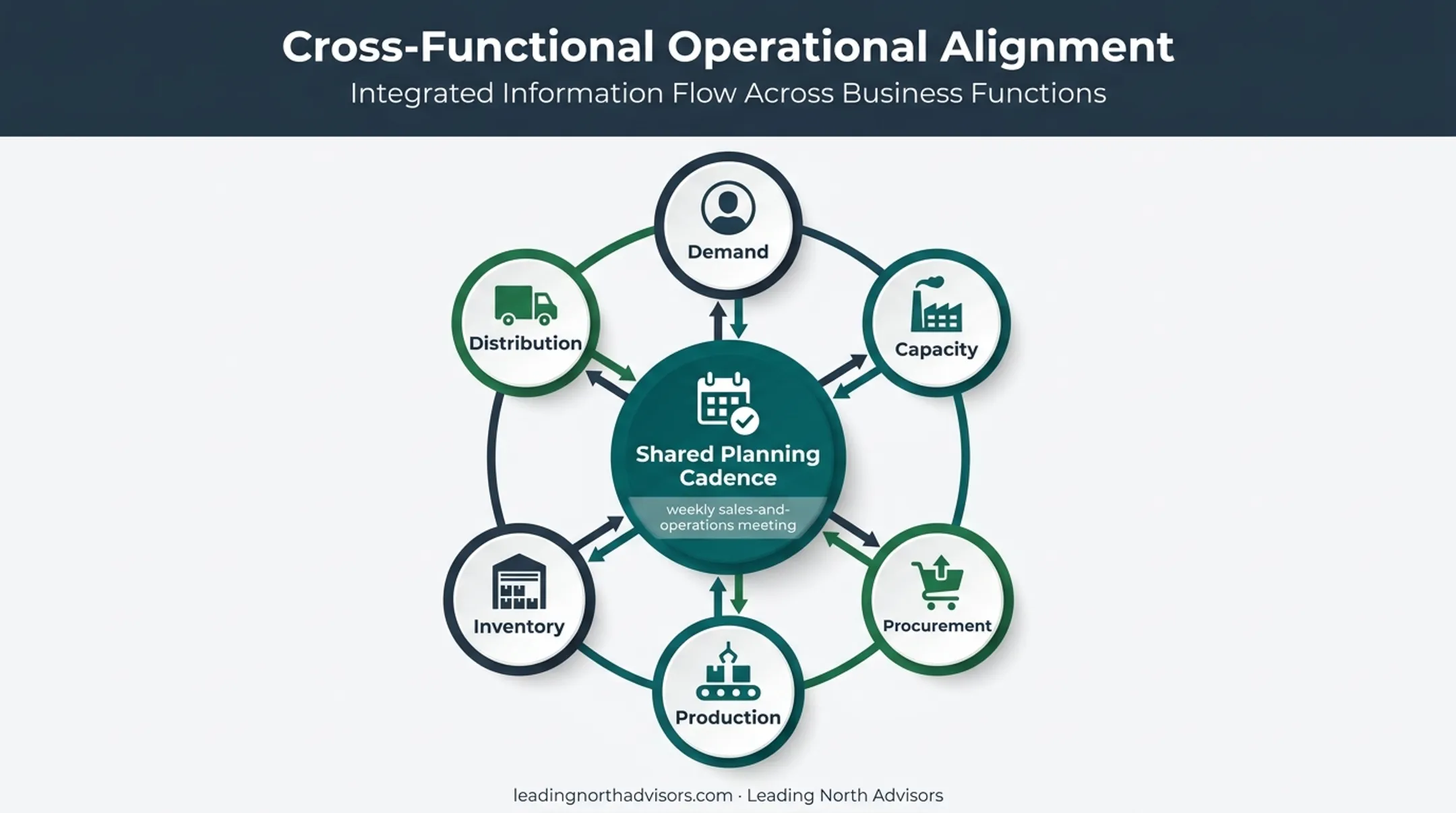

Integrated supply chain planning network connecting six operational functions

Integrated Visibility and Data Management

You can't coordinate what you can't see. Integration depends on a single, reliable version of the truth for item data, supplier status, inventory location, order progress, and lead times.

A 2025 MHI and Deloitte report, based on surveys of more than 700 manufacturing and supply chain leaders, found that a lack of accurate, real-time data remains one of the biggest barriers to end-to-end orchestration. Without it, informed decisions on inventory, demand shifts, and risk response become guesswork.

Visibility gaps typically show up in:

  • Supplier status and material availability
  • Production flow and quality exceptions
  • Transportation and order progress
  • Inventory location across sites

Integrated Execution and Standard Processes

Standardized workflows connect purchasing, receiving, production scheduling, replenishment, and fulfillment so handoffs don't get lost.

This is where Lean methods earn their place: value-stream mapping exposes where flow breaks down, pull systems replace push-based overproduction, and visual management makes problems visible before they escalate.

Standardization shouldn't mean rigidity everywhere. Consistency matters most where variation creates cost or risk: regulatory documentation, quality checks, safety protocols. Local flexibility still has a place for product-specific or site-specific needs.

Supplier and Partner Collaboration

Shared forecasts, specifications, and delivery requirements turn suppliers from order-takers into partners who can plan ahead. Escalation procedures and joint performance reviews keep small issues from becoming crises.

Supplier scorecards work best when they go beyond purchase price. A useful scorecard should track:

  • On-time delivery and lead-time reliability
  • Quality performance and defect rates
  • Responsiveness during disruptions
  • Participation in joint improvement efforts

None of this requires consolidating your supplier base or bringing suppliers under company ownership. It comes down to building better relationships with the suppliers you already have.

Integrated Performance Management

A balanced KPI framework prevents one department from optimizing itself at another's expense. Cover service level, on-time delivery, inventory health, forecast accuracy, quality, cost, and supplier performance together, not in isolated reports.

A practical governance cadence might look like:

  1. Daily operational reviews at the site or shift level for immediate issues
  2. Weekly cross-functional reviews to catch trends before they compound
  3. Monthly strategic reviews tying performance back to business goals

This structure moves teams from reactive firefighting toward catching problems before customers ever notice.

Integrated Supply Chain Solutions: Benefits and Common Challenges

Benefits of Integrated Supply Chain Solutions

End-to-end visibility helps teams catch bottlenecks, shortages, and supplier delays before they hit customers. That's the headline benefit, but the downstream effects matter just as much.

Process integration reduces duplication and shortens decision cycles. When purchasing, production, and inventory work from the same data, fewer meetings are needed to reconcile conflicting numbers. Coordinated planning also improves inventory decisions, balancing availability against carrying costs and obsolescence risk rather than defaulting to "more is safer."

In one McKinsey-documented case, a metals producer that integrated inventory and production planning saw a 2 to 5% EBITDA increase, 5 to 10% higher on-time-in-full delivery, and a 9 to 10% inventory reduction. Those numbers reflect what happens when planning, execution, and data work together instead of separately.

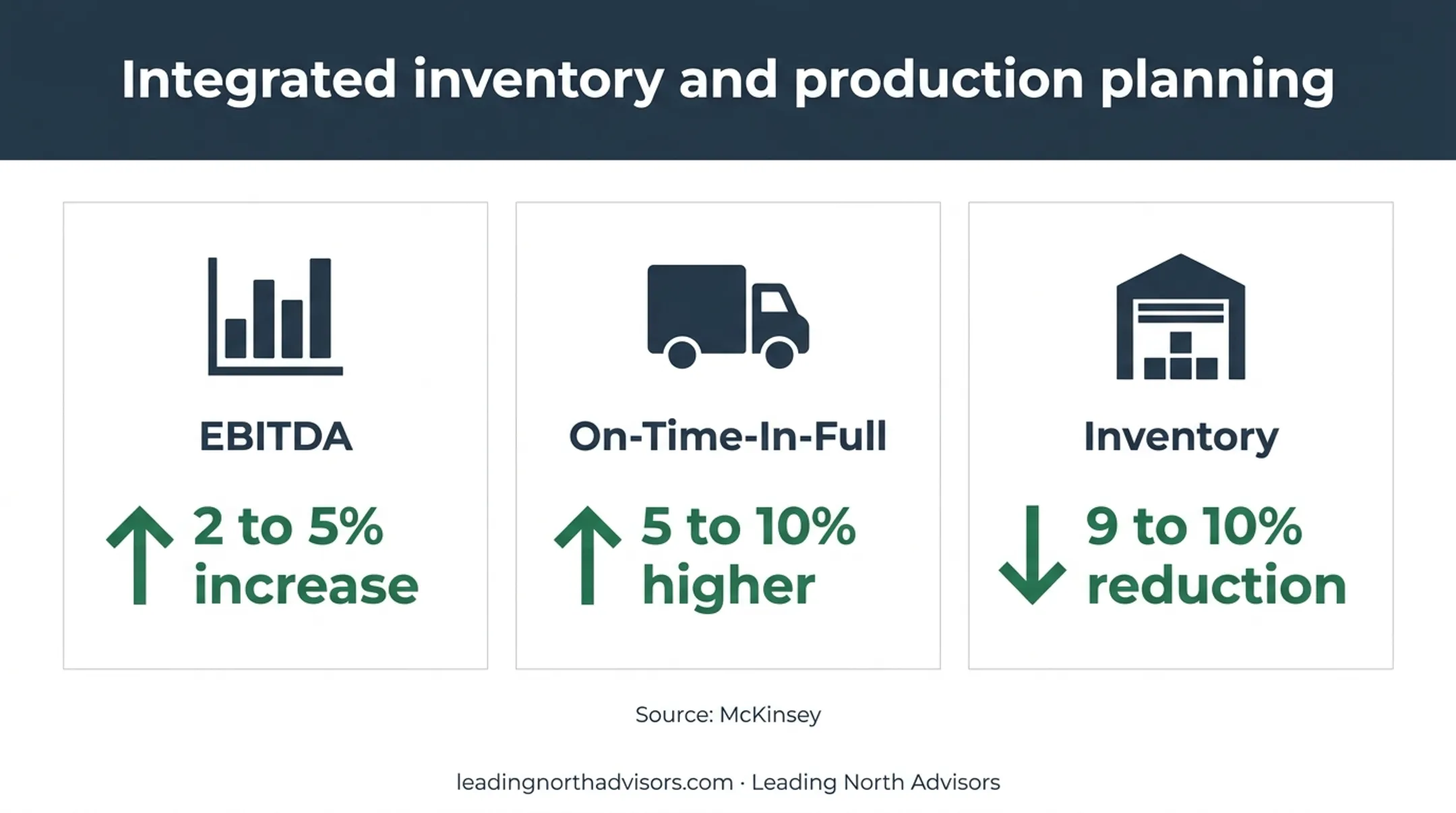

Integrated supply chain planning case study performance improvement metrics

Stronger supplier collaboration compounds these gains, improving quality and delivery reliability through joint problem-solving rather than one-sided pressure on price.

Common Challenges and Trade-offs

Integration isn't free, and pretending otherwise sets up unrealistic expectations. Real trade-offs include:

  • Implementation cost and complexity: data cleansing, system integration, process redesign, and training all take time and budget
  • Over-centralization risk: heavy dependence on one system or supplier creates a single point of failure
  • Cybersecurity exposure: connecting more systems means more potential entry points
  • Frontline resistance: standardized processes imposed without input from the people doing the work tend to get ignored, not adopted

McKinsey's case research illustrates this well. One life-sciences transformation was terminated after six months because it focused mainly on IT and lacked a clear connection to business priorities.

A redesigned effort using cross-functional working groups later identified over $250 million in savings potential, achieved by aligning the initiative with actual business problems rather than installing new software.

That's the core lesson: technology cannot correct unclear ownership, unstable processes, or conflicting incentives. Those foundations need attention before any system goes live.

How to Implement an Integrated Supply Chain

Assess the Current State and Define the Business Case

Start by mapping the end-to-end value stream across suppliers, sites, and functions. Look for delays, rework, excess inventory, and information gaps. At Leading North Advisors, Value Stream Analysis engagements build this map from observed data on the floor, not assumptions from management reports, because what people assume is happening and what's actually happening rarely match.

Establish a baseline using real operational and financial measures before defining the specific problems integration needs to solve. Skip generic industry savings claims. Build the case from your own data.

Align Leadership, Teams, and Governance

Integration efforts stall when they cross departmental boundaries without executive authority to act. A shared vision, clear decision rights, and an assigned executive sponsor are non-negotiable.

Equally important: frontline involvement. Employees who perform the work uncover practical constraints that leadership alone will miss. Leading North Advisors' True North Delivery® framework builds this in through its change-management-led approach, integrating client teams at every step through training and hands-on knowledge transfer rather than handing them a finished plan.

Design the Future-State Operating Model

Define which processes need enterprise-wide consistency and which require local adaptation for product, regulatory, or facility differences. Not everything should be standardized. That's a deliberate design decision, not an oversight.

Lean tools support this design work directly:

  • Value-stream mapping to visualize the future state
  • Standard work and visual controls to lock in consistency
  • Daily management routines to catch deviations early
  • Structured root-cause problem-solving for recurring issues

Connect Systems and Improve Data

Evaluate whether existing ERP, planning, and warehouse systems can actually exchange the data integrated decisions require. Technology selection should follow clearly defined processes and KPIs, rather than drive the transformation.

Address master-data ownership, data quality controls, and access rights before assuming a new system will fix an old problem. A tool connected to messy data just moves the mess faster.

Pilot, Measure, Scale, and Sustain

Start with a contained pilot: one site, one product family, one value stream, rather than an organization-wide rollout.

This mirrors the phased approach behind Leading North Advisors' Managing for Daily Improvement (MDI) rollout. The program moves through five stages: leadership alignment and metric definition, standard work and training, pilot launch, scale with guardrails, and sustain through coaching.

Five-stage phased supply chain improvement rollout process

A typical 90-day pilot might:

  1. Establish baseline metrics for the chosen workflow
  2. Set work-in-process limits to expose bottlenecks
  3. Address the bottlenecks that surface
  4. Expand only after the pilot stabilizes

Sustaining results afterward requires ongoing KPI reviews, audits, and employee-led improvement activity. It's not a one-time project that ends when the consultants leave.

Frequently Asked Questions

What does integrated supply chain management mean?

It's the coordinated management of planning, sourcing, production, inventory, logistics, suppliers, data, and customer demand across the entire system. Functions share information and align decisions instead of operating independently.

What are the main benefits of an integrated supply chain?

Improved visibility, faster decision cycles, better inventory control, and stronger supplier collaboration top the list. These translate into more reliable delivery and better resilience against disruptions.

What are the core components of supply chain integration?

Integrated planning, shared data and visibility, coordinated execution, supplier collaboration, and performance management form the foundation. Technology connectivity supports these components but doesn't replace them.

Does supply chain integration require new software?

Not necessarily. Technology can enable visibility and connectivity, but integration also depends on process standardization, data quality, aligned goals, and employee adoption — factors software alone can't fix.

How do companies begin implementing an integrated supply chain?

Start by assessing the current state and building a business case from real data. From there, align stakeholders, design the future-state process, pilot changes on a small scale, and expand gradually based on results.

How does Lean support supply chain integration?

Lean connects value-stream thinking, waste reduction, and standard work with end-to-end performance. Tools like visual management and structured problem-solving help teams sustain improvements instead of losing them after the initial rollout.
