Rapid Improvement Workshop and Event

Introduction

Your team has run the same status meeting for months. Delays keep happening. Rework keeps piling up. Handoffs between departments still fall through the cracks, and nobody owns the fix.

Sound familiar? Many operations leaders struggle with this exact pattern: routine meetings that surface problems but never solve them, plus isolated fixes that don't stick.

A Rapid Improvement Workshop, also called a Rapid Improvement Event (RIE) or Kaizen Event, breaks that cycle. It's a focused, collaborative Lean intervention built around a specific process problem.

Teams observe the work directly, test countermeasures on the spot, and establish a better way of working, often within days.

This guide covers four things:

  • Deciding whether an event fits your situation
  • Preparing the right team
  • Running the workshop itself
  • Making sure the gains actually last

Key Takeaways

  • Define the problem, process boundaries, target condition, and decision authority before the team ever meets
  • Involve the people who do the work, not just managers, in observation, root-cause analysis, and testing
  • Treat an event as a momentum-builder, not a replacement for ongoing Lean discipline
  • Measure results against a documented baseline and assign follow-up actions to named owners

What Is a Rapid Improvement Workshop and When Should You Use One?

Rapid Improvement Workshop, Rapid Improvement Event, Kaizen Event, and Kaizen Blitz are largely interchangeable terms. All describe a short, high-focus improvement effort with a defined scope and a measurable objective. Organizations use different labels, but the underlying approach is consistent.

What makes an event different

A true Rapid Improvement Event has five defining traits:

  • A cross-functional team, not a single department working alone
  • Direct observation at the actual place where the work happens
  • A narrow, well-defined process boundary
  • Rapid, real-world testing of countermeasures during the event itself
  • Documented follow-through after the team disbands

Compare that to a routine team meeting (discussion without testing), a brainstorming session (ideas without implementation), or a major capital project (months of planning and capital approval). An RIE sits in a specific niche: fast, hands-on, and bounded.

When to choose an event over other approaches

According to a 2016 decision guide from MRSC, an intensive Kaizen Event works best when the problem crosses multiple organizational areas, is pressing, and the organization already has performance measures in place and trusts Lean tools.

When a team still needs to define measures or gather baseline data, a slower workshop format, such as recurring 1.5 to 2-hour sessions over several weeks, often produces better results.

Ask these questions before committing to an event:

  1. Is the problem specific enough to study in a few days?
  2. Is the relevant process physically or digitally accessible to the team?
  3. Can this team actually influence the outcome, or does the fix require capital approval?
  4. Can improvements realistically be tested within the workshop window?

If the answer to all four is yes, an RIE is likely the right tool.

Good candidates across US industries include:

  • Reducing changeover delays on a production line
  • Improving patient flow through an emergency department
  • Cutting scrap in a food-processing plant
  • Reducing rework on a construction site
  • Shortening a permit backlog in a public-sector office

How to Plan a Successful Rapid Improvement Event

Planning determines whether an event produces real change or just another action list nobody follows.

Build the charter first

A concise problem statement and project charter should define:

  • The current condition and its business or customer impact
  • Process boundaries (where the scope starts and stops)
  • The target condition and expected deliverables
  • Assumptions and exclusions the team agrees to upfront

Establish a baseline before touching anything

Agree on the measurement method before changing the process. Capture only the metrics that describe the problem:

  • Cycle time and lead time
  • First-pass yield and defect frequency
  • Wait time and inventory levels
  • Safety observations or cost Skip this step and the team is left with guesswork—and no way to prove the countermeasure worked.

Select the right team

Effective cross-functional teams include:

  • People who perform the work day to day
  • Upstream and downstream partners
  • The process owner
  • An empowered decision-maker In our experience running these events across manufacturing, healthcare, and public-sector clients, teams of eight to twelve participants balance diverse input with workable group dynamics. Avoid an oversized group dominated by senior leaders who never sit in the meetings where the problem actually shows up.

Handle the logistics

Before day one, confirm:

  • Participant availability for the full event window
  • Access to the work area, including any safety requirements
  • Existing process documentation and data access
  • A visible method for tracking actions (whiteboard, shared tracker, or physical action board) Set expectations early: the event should test and implement practical improvements, not produce a slide deck of recommendations. Confirm which decisions the team can make on the spot and which require escalation. When teams want experienced facilitation—or need the event tied to a broader Lean transformation—Leading North Advisors pairs hands-on workshop support with change management so the week connects to sustained results.

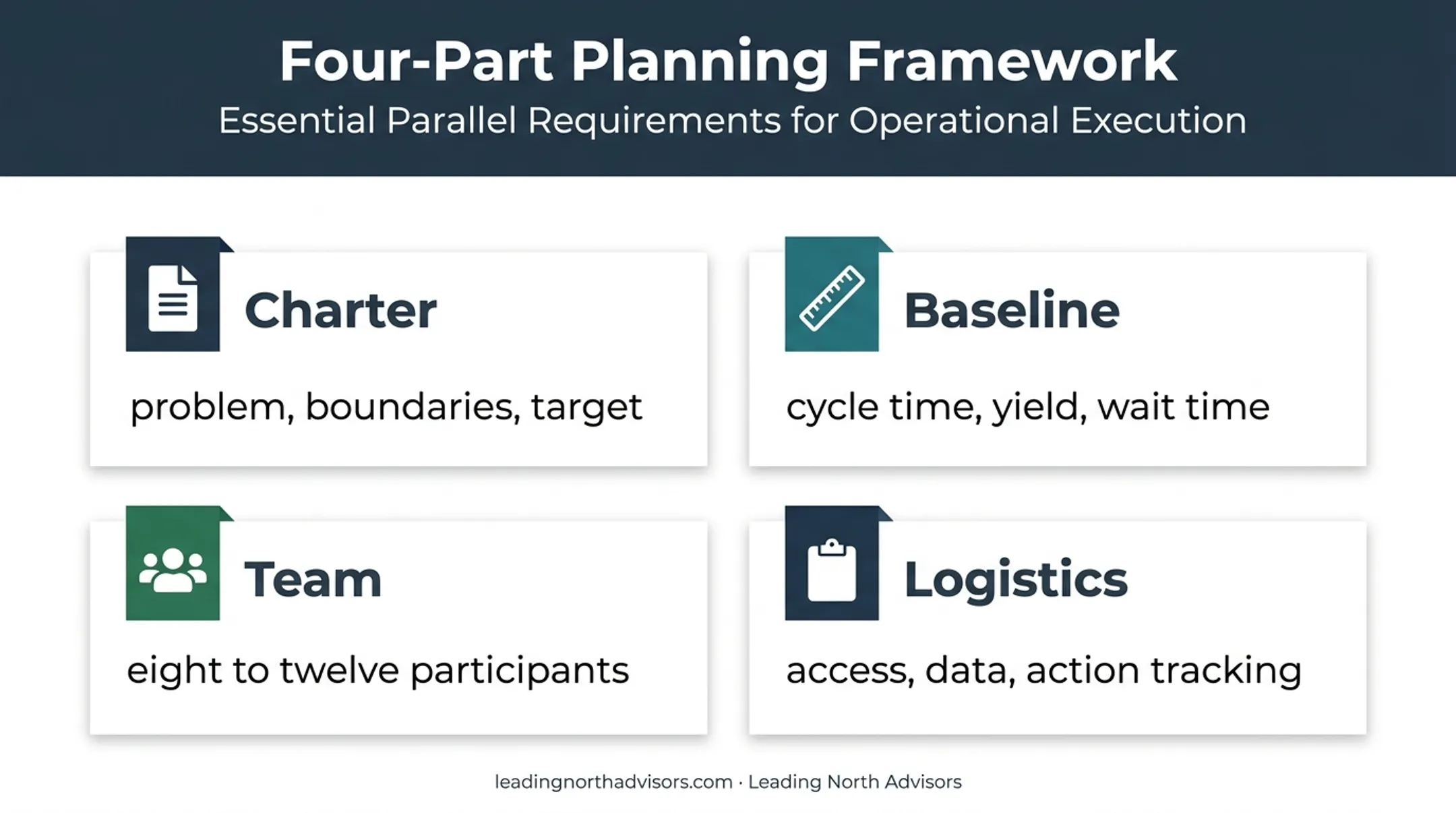

Four-part Rapid Improvement Event planning framework infographic

How to Run the Workshop: From Current State to Tested Improvement

Once the team is assembled, the workshop itself typically follows a consistent arc.

Align, then observe

Start by aligning everyone on the problem, the customer or stakeholder need, baseline measures, scope, and roles. Provide brief instruction in Lean concepts if the group needs it. Then go to where the work happens.

Document the current state with a process map, value-stream view, spaghetti diagram, or swimlane map—whichever tool fits the problem. Separate what you actually observed from what people assume is happening. These are rarely the same thing.

Find the root cause, not the symptom

Use tools like the 5 Whys, fishbone analysis, and Pareto analysis to dig past the obvious complaint. A supervisor might say the line stops because operators are slow. Five Whys later, the real issue is often a parts staging problem three steps upstream.

Generate and test countermeasures

  1. Brainstorm countermeasures that address the root cause, not just the visible symptom
  2. Prioritize with an impact-versus-effort assessment, weighing safety, quality, compliance, and customer needs
  3. Test the top ideas in the real process when you can, with a controlled trial and clear proof of what worked
  4. Adopt, adjust, or discard based on what the data actually shows

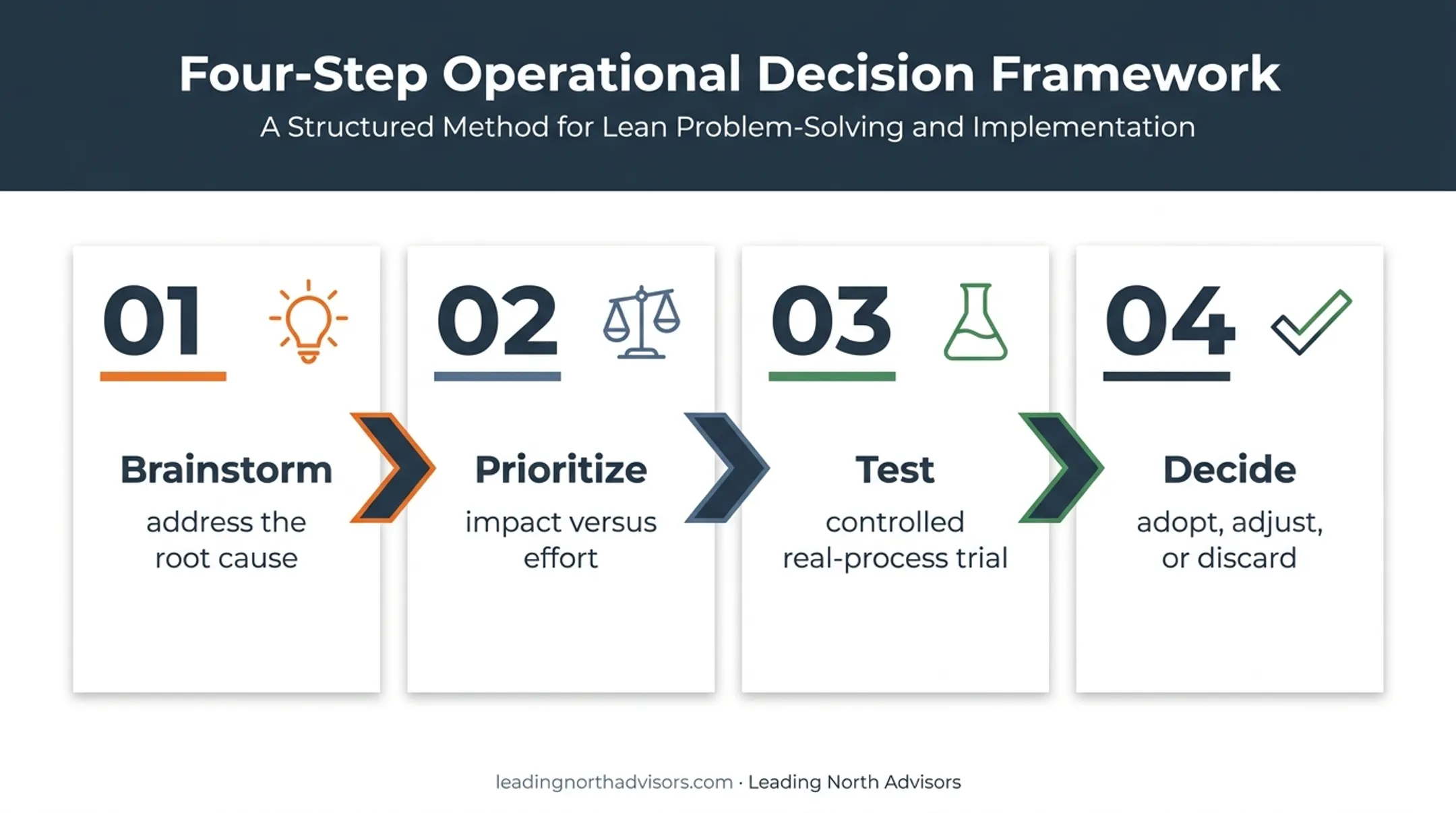

Four-step countermeasure testing process for Rapid Improvement Events

Close with a documented future state

End the event with clear handoffs so the gains hold after the room empties:

  • Documented future-state process
  • Action register with named owners and due dates
  • Unresolved issues and risks
  • Updated measures
  • Communication plan for affected employees and leaders who weren't in the room

What Benefits Can a Rapid Improvement Event Deliver?

Done well, a focused event delivers operational gains that routine meetings rarely produce:

  • Smoother flow with less unnecessary motion and waiting
  • Handoff failures exposed where work actually breaks down
  • Quality problems caught closer to the source
  • Processes frontline staff can run more consistently

Leadership gains often follow the operational ones:

  • Clearer visibility into how the process actually performs, versus how it's assumed to perform
  • Faster decision-making, since the data and the decision-makers are in the same room
  • Stronger accountability, with named owners instead of vague action items
  • Better alignment across functions that previously worked in isolation

There's a cultural dividend too. Involving frontline employees in diagnosing problems and designing solutions builds ownership that outside consultants can't manufacture alone.

No event guarantees a specific savings figure or immediate financial return. Results still depend on scope, team engagement, and follow-through.

Industry patterns worth noting:

  • Manufacturing and automotive: changeover time and defect reduction
  • Hospitals and health systems: patient flow and supply waste
  • Food and beverage: line uptime and scrap reduction
  • Construction: rework reduction and field productivity
  • Public sector: backlog reduction and processing time

What the research actually shows

A 2023 study published in BMJ Open examined 26 Kaizen Events across specialized units in a large academic hospital system in southern Finland. Thirteen units achieved long-term improvement, three could not sustain their gains, and five struggled to improve at all.

Kaizen Event research outcomes across 26 hospital units

Researchers tied persistence to workload, preparation, and follow-up—not the event itself. The event creates the opening; what happens afterward determines whether it holds.

How to Sustain Improvements After the Workshop

This is where most events either pay off or quietly fade.

Make it standard work, not a memory

Convert successful countermeasures into standard work, visual controls, updated procedures, and clear process-owner responsibilities. Undocumented improvements tend to disappear within weeks because the next busy day reverts everyone to the old habit. Standard work gives the team a documented baseline, so any deviation becomes a visible starting point for the next improvement, rather than a silent slide backward.

Build a follow-up cadence

Set short-term checks and longer-term reviews using whatever governance method your organization already runs. That can mean action-status reviews, leader standard work, Gemba walks, or daily management huddles.

Keep measuring the same baseline indicators you started with. Confirm the gains haven't created new problems in safety, workload, or an upstream process nobody thought to check.

Document the learning

An A3 report, or an equivalent one-page record, should capture the problem, current state, root causes, countermeasures, and results. This keeps the reasoning transparent and makes the knowledge transferable to the next team facing a similar issue.

Assign ownership for what's unfinished

Not every issue gets solved in the workshop window. Establish clear ownership for incomplete actions and a real escalation path for barriers the event team can't resolve on its own. Enthusiasm fades. A governance mechanism doesn't.

Organizations building this muscle over time often pair individual events with broader capability-building, such as Managing for Daily Improvement routines, leadership development, or industry-tailored Lean certification programs.

Leading North Advisors offers this kind of ongoing support for teams that want to build internal capability. Plenty of organizations also run successful one-off events without continued consulting.

Frequently Asked Questions

What is a rapid improvement process?

It's a structured sequence: clarify the problem, observe the current state, identify root causes, test countermeasures, measure results, and standardize what works. Each step builds on evidence from the one before it.

What are the 5 Lean principles of process improvement?

The five principles, as outlined by ASME, are value, value stream, flow, pull, and perfection. A Rapid Improvement Event puts these into practice by mapping the value stream, removing flow interruptions, and testing changes against real demand.

How long does a rapid improvement event take?

Duration depends on scope, complexity, and how ready the data is. Most events run between one and seven days, with three to five days being the most common range for a focused, single-process problem.

Who should participate in a rapid improvement workshop?

Include the people who perform the work daily, upstream and downstream partners, the process owner, an empowered decision-maker, and a skilled facilitator. Leaving out frontline staff is the fastest way to design a solution nobody actually uses.

What is the difference between a Kaizen event and a rapid improvement event?

In practice, the terms are used interchangeably to describe a short, focused Lean improvement effort. Some organizations use different labels or place slightly different emphasis on specific tools, but the core approach is the same.
