5S Implementation in Construction Sites Walk any active jobsite and you'll see it: tools buried under debris, materials staged in the wrong spot, crews backtracking across the site to find a ladder or a box of fasteners. Multiple trades share tight space, work zones shift weekly, and temporary storage rarely keeps pace with the schedule.

5S is a Lean method built to fix exactly this. It organizes, cleans, standardizes, and continuously improves how a work area functions.

This guide is written for general contractors, specialty contractors, site leaders, and safety teams across the US. One thing needs to be clear up front: 5S supports your site-specific safety plan, hazard controls, and OSHA requirements. It doesn't replace them.

Many crews reduce 5S to "keeping the site clean." That undersells it. Done right, 5S makes sure the right tools, materials, information, and controls show up in the right place at the right time. Below, we'll define each S, walk through a construction-specific rollout sequence, cover what affects results, and explain how to keep the system alive as the project changes.

Key Takeaways

  • Apply Sort, Set in Order, Shine, Standardize, and Sustain to tools, materials, equipment, work zones, and information
  • Cut wasted motion, searching, congestion, material damage, and housekeeping-related hazards
  • Revisit standards as phases, crews, access routes, and material needs change
  • Build ownership by involving foremen, trades, and subcontractors in creating standards—not only following them
  • Track site-specific indicators, then use audits and coaching to keep improving

What Is 5S in Construction?

5S is a five-step Lean workplace-organization method: Sort, Set in Order, Shine, Standardize, and Sustain. The Lean Enterprise Institute traces these back to the Japanese terms Seiri, Seiton, Seiso, Seiketsu, and Shitsuke, though most US contractors just use the English versions on toolbox talks and signage.

On a construction site, the goal isn't a tidy photo for the owner's walkthrough. It's a work area where crews can find, use, return, and inspect tools, materials, equipment, and documents without hunting for them.

Beyond Cleanliness

5S touches more than dirt and clutter. It addresses:

  • Excess inventory sitting in staging areas
  • Unclear or undefined storage locations
  • Inefficient movement between tasks
  • Inconsistent routines from shift to shift
  • Visual abnormalities that signal a bigger problem

5S vs. Housekeeping vs. Inspections

These three get confused constantly, but they solve different problems:

  • Housekeeping removes dirt and debris from the site
  • Inspections identify hazards or compliance gaps at a point in time
  • 5S builds a repeatable operating system so disorder doesn't come back

The Lean Enterprise Institute draws the same line: 5S goes deeper than a one-time cleanup by creating standards that reveal problems and a workplace that is largely self-explaining and self-ordering.

5S sits inside the broader Lean construction toolkit, alongside kaizen events, standard work, and pull planning. No OSHA standard requires it by name. It's an operational practice that helps crews meet safety and quality requirements more consistently.

Why 5S Is Used on Construction Sites

Construction sites create their own chaos. Multiple trades share limited square footage. Work zones move as phases progress.

Access routes change overnight, equipment gets relocated, and materials get staged and re-staged. Handoffs between crews happen constantly. A layout that worked in week two might create bottlenecks by week six.

The Safety Connection

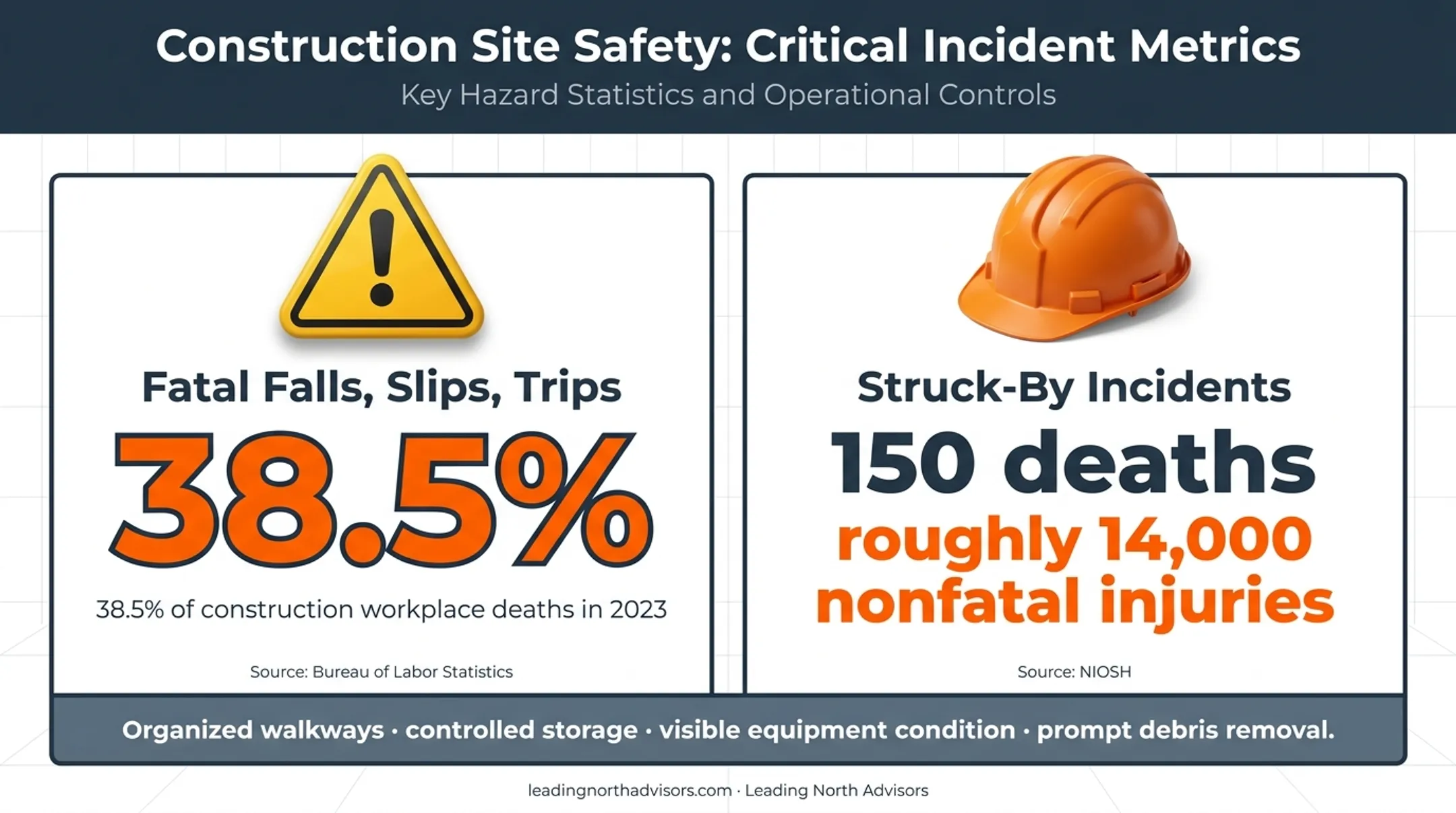

Disorganization creates real safety hazards. In 2023, falls, slips, and trips accounted for 38.5% of all construction-industry workplace deaths, according to the Bureau of Labor Statistics. Construction made up nearly half of all fatal falls, slips, and trips across every US industry.

Blocked walkways, mislabeled storage, and debris left in access paths all contribute to that risk.

Struck-by incidents tell a similar story. NIOSH reported 150 occupational struck-by deaths and roughly 14,000 nonfatal injuries in construction in a single year, much of it tied to equipment and material movement in congested work zones, according to NIOSH.

Organized walkways, controlled storage, visible equipment condition, and prompt debris removal address the exact conditions behind those numbers.

Construction safety statistics linking site organization to hazard reduction

Productivity, Quality, and Cost

A cluttered site costs time in ways that are easy to overlook:

  • Crews searching for tools instead of working
  • Extra trips across the site for materials that should be staged nearby
  • Delayed handoffs because the next crew can't find what they need
  • Damaged materials from poor storage or protection
  • Rework caused by using the wrong item or missing a defect

None of this needs a dramatic case study to understand. It's the accumulation of small delays that erodes schedule and margin over the life of a project.

Workforce and Culture

5S works best when crews help design it. When foremen, operators, and subcontractor teams build the standards together, they follow them. Communication across the GC-subcontractor network usually improves with it.

5S is an operational improvement method, not a legal requirement. It complements OSHA standards, your site safety plan, and existing hazard controls. It doesn't replace any of them.

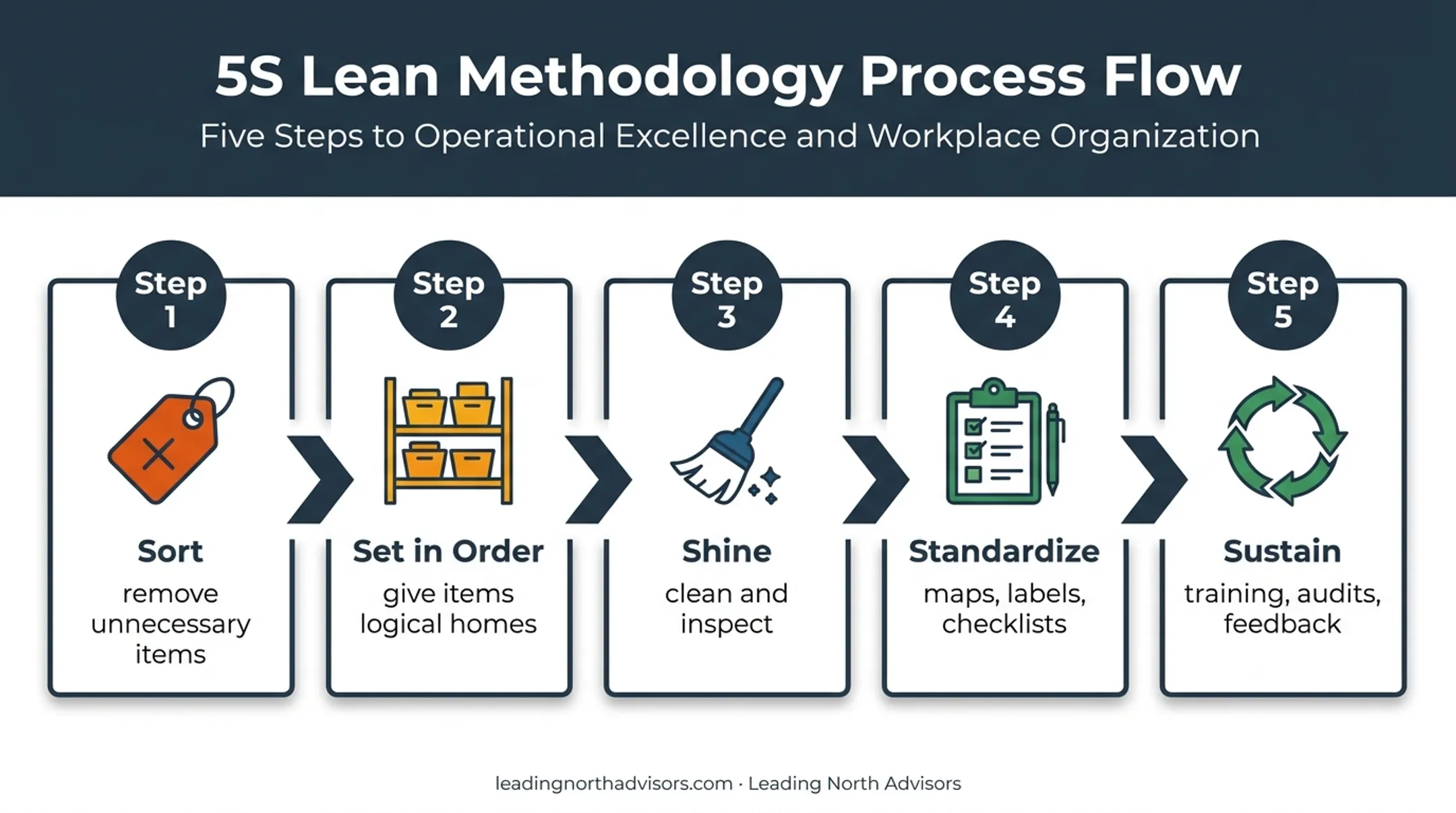

How 5S Implementation Works

A 5S rollout works best as a sequence, not a single event:

  1. Select a pilot area and observe current work
  2. Remove what's unnecessary, then organize what's left
  3. Clean and inspect, and set visual standards
  4. Train the crew, audit performance, and adjust as conditions change

Start with one defined area, such as a tool crib, material laydown yard, prefabrication zone, equipment staging area, or a single active floor. A site-wide rollout without a baseline usually stalls. There's too much to fix at once and no way to tell what's working.

Before changing anything, document baseline conditions: search time for common tools, blocked paths, misplaced items, damaged materials, housekeeping findings, rework causes, and worker feedback. Track only what the project can realistically collect.

1. Sort

Sort separates what a crew actually needs from what's obsolete, duplicate, damaged, idle, or simply misplaced. Everything else creates clutter that slows the real work down.

For flagging items, adapt the red-tag method used in manufacturing: tag the item, note the owner, the reason it's under review, the proposed disposition, and a review date. Then relocate, return, recycle, repair, or dispose of it. Don't skip straight to the dumpster.

A few guardrails matter here. Don't remove safety-critical equipment, regulated materials, owner-furnished items, or anything needed for a later phase without approval and a paper trail.

Example: A framing crew separates daily-use tools (nail guns, levels, tape) from phase-specific equipment not yet needed, excess consumables, damaged lumber, and materials that belong to the electrical sub staged in the wrong bay.

2. Set in Order

Once the unnecessary items are gone, give everything that's left a logical home based on how often it's used, the sequence of the work, ergonomics, security, weather exposure, and how equipment moves through the space.

Practical controls that hold up on real sites:

  • Labeled storage zones and floor markings
  • Shadow boards for hand tools
  • Racks, bins, and color coding by trade or task
  • Defined laydown areas and delivery points
  • Access routes that stay clear regardless of what's being delivered

Because sites change fast, define temporary locations too: maximum quantities allowed, who owns the space, expectations for returning items, and rules for relocating storage when the phase shifts.

Example: A mechanical crew arranges pipe, fittings, and tools by installation sequence along the run instead of pulling everything from one central pile. Less crossing the floor, less digging through mixed inventory.

3. Shine

Shine is scheduled cleaning combined with inspection, not cosmetic tidying. Crews clean tools, equipment, work areas, access paths, and staging zones while checking for leaks, damage, wear, instability, or hazards forming before they become incidents.

Assign responsibility clearly by area, trade, shift, or task. Just as important, define what gets escalated instead of fixed informally. A frayed cord or a cracked ladder rail isn't a DIY repair. Only qualified personnel should handle equipment maintenance or safety-critical fixes.

Build short routines into the natural rhythm of the day:

  • Debris removal at end of shift or task completion
  • Tools returned to their designated spot
  • Spills handled immediately, not next shift
  • Materials protected from weather before crews leave
  • Access paths verified clear before walking off site

4. Standardize

Standardize turns the first three steps into instructions someone new to the site could follow: storage maps, photos, labels, checklists, inspection points, material limits, end-of-shift expectations, and clear escalation routes.

Build these standards with the people doing the work: foremen, operators, safety staff, subcontractors, material coordinators. A standard written in an office and handed down rarely survives contact with the actual jobsite.

Standards also need to align with the project schedule, site logistics plan, equipment procedures, toolbox talks, and safety requirements. Conflicting instructions from different sources are worse than no instructions at all.

Use version control, too. When the layout or phase changes, pull the outdated checklist immediately rather than letting two versions circulate at once. Leading North Advisors builds this into its process with custom 5S documentation tailored to the site rather than generic templates.

5. Sustain

Sustain is where most 5S efforts fail. It's the difference between a one-time cleanup and a management routine: training, daily habits, scheduled audits, visible leadership support, corrective actions, and ongoing feedback from the crew.

Match your review rhythm to the project. That might mean crew-level checks each shift, supervisor reviews weekly, or a full reassessment at every phase change. There's no universal frequency that fits every site.

Track a focused set of indicators:

  • Audit completion and repeat findings
  • Tool retrieval time
  • Blocked-access observations
  • Damaged-material incidents
  • Near-miss themes tied to housekeeping

When standards get missed, resist blaming the crew first. Ask whether the real cause is unclear ownership, poor layout, insufficient storage, schedule pressure, weak training, or a standard that simply doesn't work in practice.

This is where outside coaching earns its keep. Lean implementation partners such as Leading North Advisors help contractors assess workflows, get crews engaged early, and build standards that hold up under project pressure.

Through its True North Delivery® approach, teams get hands-on training rather than a binder handed off at the end of a project. Internal engagements have shown measurable gains in organization and search time within 30 to 60 days when training and practice back up the standard.

Five-step 5S construction implementation process from sorting to sustainment

Where 5S Is Applied on a Construction Site

5S belongs across the whole site, not one tidy corner. Apply it in:

  • Entrances and access routes
  • Tool cribs
  • Material laydown yards
  • Prefabrication areas
  • Active work zones
  • Temporary facilities and equipment parking
  • Waste and recycling points
  • Digital project files and drawings

Digital files count. Outdated drawing revisions and unresolved RFIs create the same clutter as a messy laydown yard, only harder to see.

Location alone is not enough. Run 5S at these moments, not only on a scheduled cleanup day:

  • Mobilization and demobilization
  • Before a new phase starts
  • After a major material delivery
  • During shift handoffs
  • After incidents or repeated audit findings

Treat 5S as condition-based. A layout that worked for foundations will not fit finishes, so review it whenever crews, materials, sequencing, or site constraints change.

Key Factors That Affect 5S in Construction

Inputs, Materials, and Equipment

Delivery sizes, material lead times, hazardous substances, weather-sensitive products, shared tools, and owner-furnished items all shape sorting and storage decisions. Build in:

  • Traceability for regulated or owner-furnished materials
  • Weather protection for moisture-sensitive products
  • Condition checks where shelf life or exposure matters
  • Coordination with procurement and logistics so storage limits match delivery schedules

Operating Conditions and Site Changes

Phases change, and sites get more constrained as structures rise. Weather, shift work, public interfaces, and simultaneous operations can turn a layout that worked last month into a hazard this month.

Review standards after any major schedule or layout change. Treating the original 5S map as permanent is one of the fastest ways to make it obsolete.

People, Ownership, and Subcontractor Coordination

Every zone, standard, audit, and corrective action needs a named owner across the GC, subcontractors, suppliers, and even visitors. Without that, "someone else's job" becomes nobody's job. Useful communication tools include:

  • Orientation sessions and toolbox talks
  • Visual instructions that don't rely on dense text
  • Multilingual materials where the workforce needs them
  • A simple feedback channel for flagging what isn't working

Safety, Quality, and Regulatory Constraints

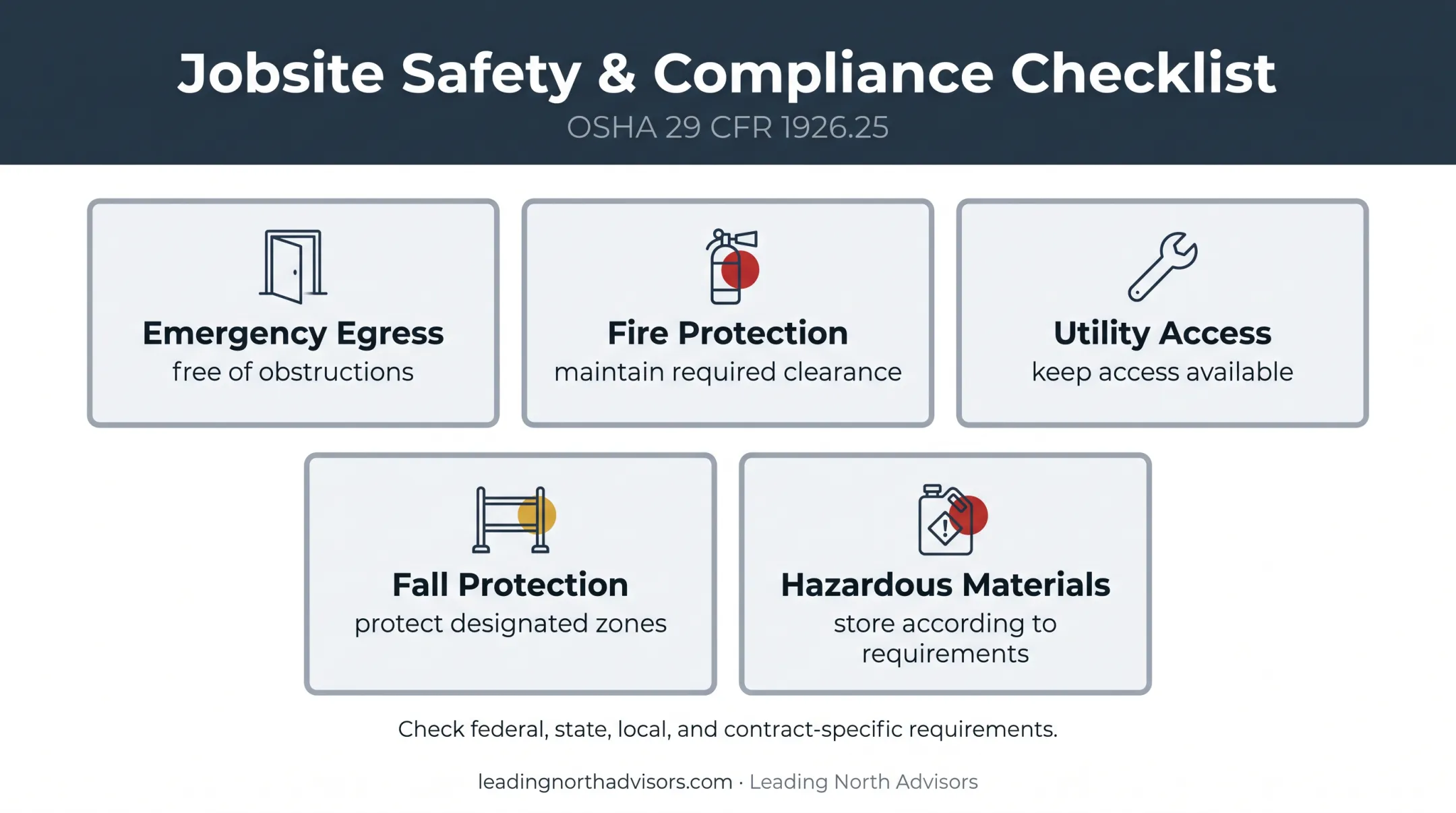

Visual organization can't come at the cost of emergency access. OSHA requires means of egress to stay free of obstructions whenever a structure is occupied under 29 CFR 1926.25.

Similar clearance rules apply to fire protection, utility access, fall protection zones, and hazardous-material storage.

5S standards should be checked against these requirements, not assumed to satisfy them. Verify what applies to your project (federal, state, local, and contract-specific) before finalizing a layout.

Construction 5S layout compliance checks for access and safety requirements

Common Misconceptions and When to Modify the Approach

5S isn't a deep clean, a one-day event, or a way to make a site look good for an inspection. Labels and floor markings can't fix bad logistics, insufficient storage, unclear sequencing, or unsafe work methods underneath them.

The newest, most polished layout isn't automatically the best one either. Test it against how workers actually move, not how it looks on paper.

Rigid, permanent layouts don't suit everything. Highly mobile work, emergency response, short-duration tasks, and fast-changing phases need flexible zones and temporary standards instead.

Watch for signs of over-implementation:

  • Excessive labeling that nobody reads
  • Duplicate checklists covering the same task
  • Controls that slow down critical work
  • Rules that conflict with safety or access requirements

If workers can't follow the standard, materials keep getting relocated, or audits turn up the same findings every time, that's a signal to pause and redesign, not to enforce harder.

Conclusion

5S gives construction teams a structured way to remove what's unnecessary, organize what's left, clean and inspect work areas, standardize expectations, and sustain the improvement over time. None of that happens by copying a factory floor plan or running a one-time cleanup before a big walkthrough.

The value comes from applying the method to your actual workflows and revisiting it as the project moves through phases, crews, and site conditions.

Put it to work in the field:

  • Start with one defined area
  • Involve the crews who use it every day
  • Measure outcomes that matter to schedule and safety, not just appearance

If your internal team needs structured guidance building that system, Leading North Advisors provides Lean implementation and training support built around real project application, not generic templates.

Frequently Asked Questions

What are the 5S in construction?

5S stands for Sort, Set in Order, Shine, Standardize, and Sustain. On a jobsite, that means separating needed tools from clutter, giving materials a defined home, cleaning and inspecting work areas, and keeping those standards in place as work continues.

What are the steps of 5S implementation?

Implementation typically follows an assessment of current conditions, sorting, organizing what remains, cleaning and inspecting, standardizing the routine, and training the crew. Ongoing auditing and adjustment keep the system working as the site changes.

How does 5S improve construction site safety?

Organized storage, clear access routes, and routine inspection help reduce trip hazards, blocked egress, and struck-by exposure. 5S supports safety performance, but it doesn't replace OSHA requirements or your site-specific safety plan.

Is 5S the same as housekeeping?

No. Housekeeping removes dirt and debris at a point in time. 5S builds a repeatable system—covering sorting, organization, standard routines, and sustained discipline—so disorganization doesn't return after the cleanup crew leaves.

How do you sustain 5S on a construction site?

Sustaining 5S takes clear ownership, ongoing training, recurring audits, and a feedback channel for workers. Review standards whenever the project moves into a new phase, since a layout that worked before rarely fits the next stage.

Who should be responsible for 5S implementation?

Leadership needs to provide resources and hold teams accountable, but superintendents, foremen, safety staff, subcontractors, and workers should jointly design and maintain the standards that keep the site running.
