Network Optimization for Supply Chain Every supply chain leader juggles the same six variables: cost, delivery speed, inventory, capacity, resilience, and customer expectations. Push one lever and another moves. Cut inventory and service drops. Add capacity and costs climb.

Network optimization solves this differently. Rather than fixing one plant, one lane, or one warehouse, it looks at how facilities, suppliers, products, transportation lanes, inventory locations, and customers all connect to each other.

Many companies still troubleshoot piece by piece, renegotiating freight rates in one region while overstocking in another. That approach patches symptoms; it rarely fixes the underlying network design.

This guide covers what network optimization means, when to pursue it, how to run a project step-by-step, where technology fits, how to measure results, and how to build resilience and sustainability into the outcome.

Key Takeaways

  • Network optimization balances data with business constraints to set facility location, product allocation, capacity, and transportation.
  • The cheapest network isn't always right: service, resilience, risk, and workforce readiness matter equally.
  • Clean data, cross-functional ownership, and scenario testing determine whether a redesign actually works.
  • Lean methods and structured change management turn network recommendations into lasting operational results.

What Is Supply Chain Network Optimization?

Supply chain network optimization is the process of testing different network configurations, then choosing the one that delivers the best feasible balance of cost, service, capacity, risk, and strategic goals. It's a structured way to answer questions that touch multiple functions at once.

What the Model Actually Looks At

A network optimization project typically examines:

  • Supplier locations and capacity
  • Plants, warehouses, and distribution centers
  • Transportation modes and lanes
  • Customer regions and demand patterns
  • Inventory positioning across nodes
  • Product flows and facility capacity limits

Each element affects the others. Moving a distribution center closer to customers might cut delivery times but strand inventory farther from suppliers.

Network Design vs. Daily Logistics

Network design and day-to-day logistics solve different problems:

  • Network design addresses structural questions: where facilities should sit, how many are needed, and which markets each one should serve.
  • Execution improvement manages ongoing decisions inside that structure, like daily routing, load consolidation, or carrier selection.

Better daily execution cannot fix a poorly designed network. When the footprint is wrong, the structure itself has to change.

Network optimization typically informs decisions such as:

  1. Opening, closing, relocating, or resizing facilities
  2. Reassigning customer demand to different sites
  3. Changing product flow paths between plants and warehouses
  4. Repositioning inventory across the network
  5. Comparing transportation mode and carrier options

Optimization informs decisions; leadership still owns the call. Model outputs need review against contracts, regulations, labor agreements, and what the organization can actually execute.

A model might recommend the mathematically cheapest footprint. If that path means closing a unionized plant mid-contract or breaking a customer service agreement, the "optimal" answer is not feasible.

Take a multi-site manufacturer with three plants and five regional warehouses comparing a consolidated footprint (two plants, three warehouses) to the current structure. The analysis should weigh total landed cost, customer lead times, plant capacity limits, and single-region disruption risk—not only which option produces the lowest freight bill.

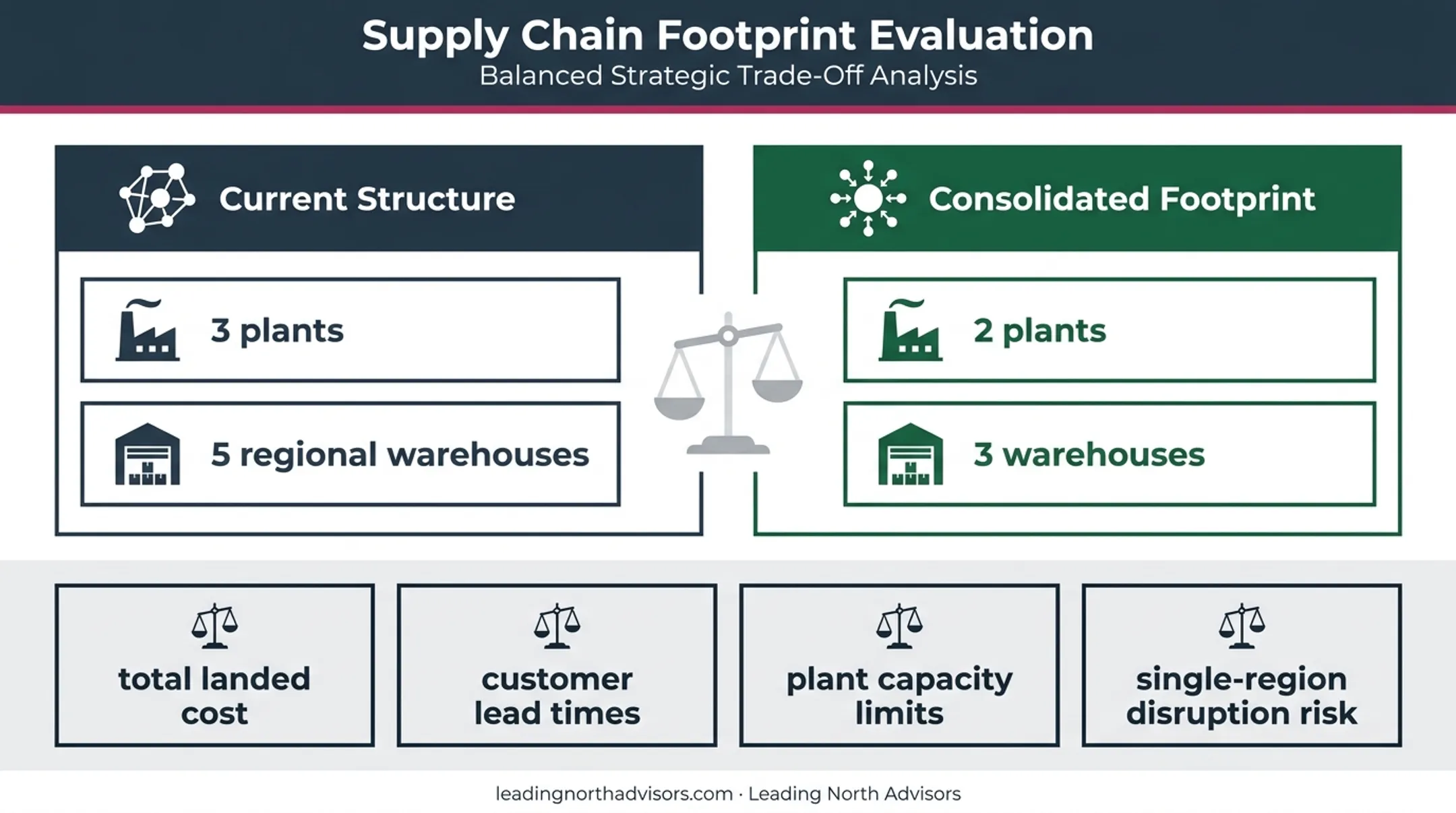

Current versus consolidated supply chain network footprint comparison

When Should an Organization Optimize Its Supply Chain Network?

Some signs point inward. Others come from outside the business. Either way, waiting too long usually costs more than the project itself.

Internal Warning Signs

Watch for:

  • Persistent cost pressure that budget cuts alone can't solve
  • Rising inventory without matching service improvement
  • Inconsistent service levels across regions or customer segments
  • Frequent expedited shipments to cover planning gaps
  • Facilities running well under or over capacity
  • Duplicated product flows between sites, or recurring capacity constraints in peak periods

External Triggers

Outside pressures can raise the question even when internal metrics look stable:

  • Major demand shifts or new market entry
  • Mergers and acquisitions that add overlapping facilities
  • Supplier disruption, or reshoring and nearshoring decisions
  • Transportation rate volatility
  • New regulatory requirements or sustainability commitments

Transportation cost swings alone can justify a review. Shipping costs rose more than 77% between January 2021 and August 2022, according to a Deloitte and Manufacturers Alliance survey of manufacturing executives, a shift large enough to change which network configuration makes financial sense.

Full Redesign or Narrower Diagnostic?

Not every trigger requires a ground-up redesign.

Factor Full Network Redesign Targeted Diagnostic
Scope Multiple facilities, regions, or business units One facility, lane, or product line
Urgency Strategic, 12-18 month horizon Operational, weeks to months
Data needs Extensive, cross-functional Focused, single dataset
Investment Higher, multi-phase Lower, faster to complete

Before choosing software or a modeling approach, define the actual business question. The question sets the scope—not the other way around:

  • "Which facilities should serve each customer region?"
  • "How much capacity do we need for next year's growth without hurting service?"

Those are different projects, with different data needs and timelines.

A Practical Network Optimization Process

A network optimization project moves through five stages. Skipping any one of them tends to produce a model nobody trusts or a plan nobody follows.

Step 1: Establish Objectives, Scope, and Governance

Name an executive sponsor, decision owners, and the functions affected. Define the planning horizon, which facilities and regions are in scope, and the specific outcomes the project must influence. Without this, the project drifts.

Step 2: Build a Reliable Baseline

Gather and validate the data the model depends on:

  • Demand history, customer locations, and product volumes
  • Supplier and plant capacities, inventory levels, and lead times
  • Facility costs, transportation rates, and service requirements
  • Labor constraints plus relevant risk or emissions data

Data definitions must match across finance, operations, procurement, logistics, and sales before modeling starts. If finance defines "cost to serve" differently than operations, the model produces numbers nobody can act on.

Step 3: Map the Current State and Identify Constraints

Document physical and information flows: bottlenecks, handoffs, capacity limits, minimum order quantities, production rules, geographic restrictions, and customer commitments. A theoretical solution that ignores a signed customer contract or a union agreement isn't a real option.

Step 4: Develop and Compare Scenarios

Model a realistic baseline, then test alternatives:

  • Facility expansion or consolidation
  • Regionalization of supply
  • Alternate sourcing strategies
  • Inventory repositioning
  • Transportation-mode changes
  • Demand growth scenarios

Run sensitivity tests across demand ranges, freight costs, lead times, labor availability, capacity changes, disruption events, and implementation timing. A single-forecast model tells you what happens if everything goes as planned. It rarely does.

Step 5: Select, Implement, and Govern the Preferred Scenario

Translate the chosen scenario into a sequenced action plan with owners, milestones, investment requirements, transition risks, and a communication plan. Set decision rules for when the network should be reviewed again as conditions change.

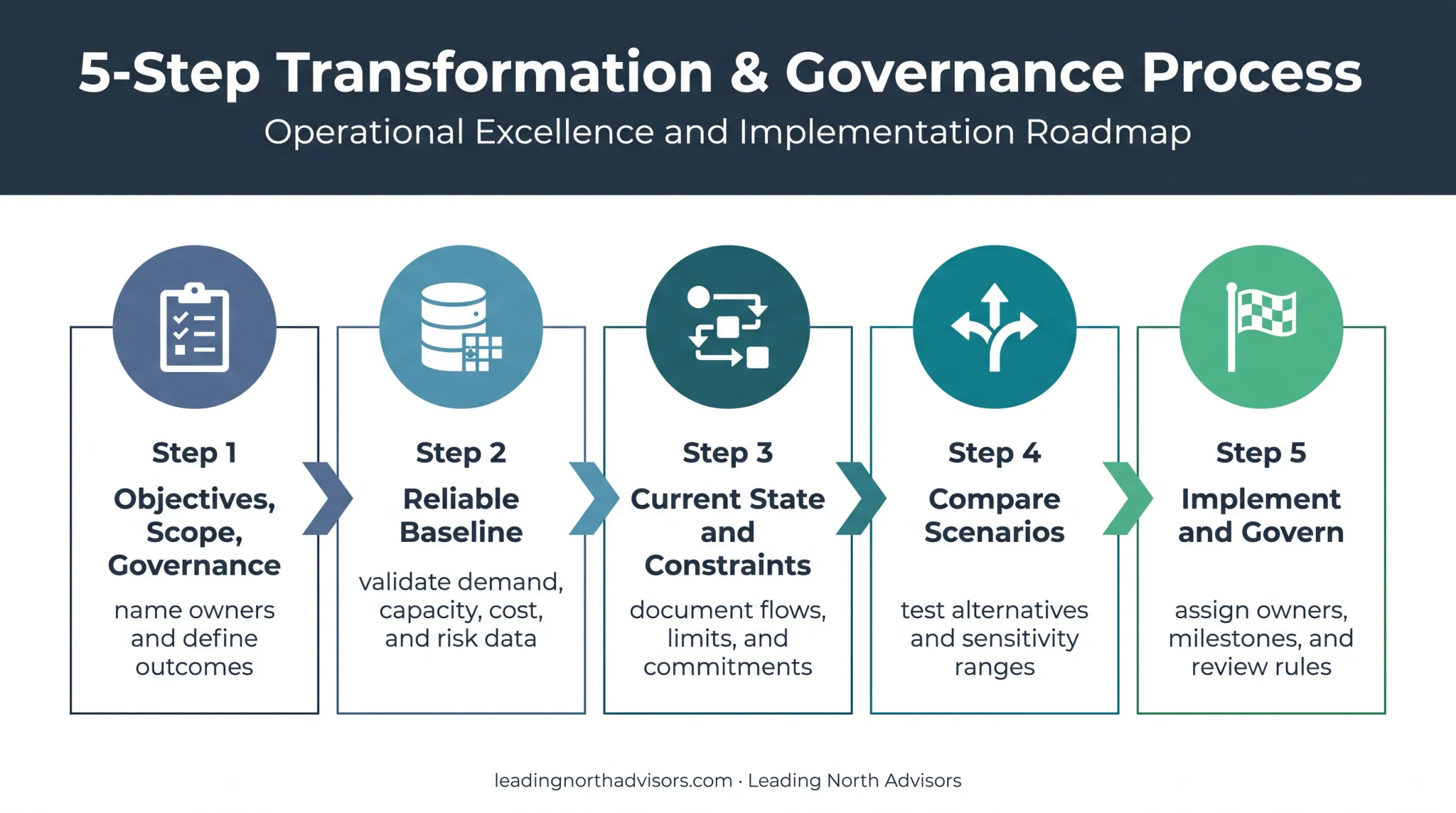

Five-stage supply chain network optimization process flow

This is where most network projects stall: a well-built model sits unused if nobody owns implementation.

Leading North Advisors focuses on the people and process side of that transition. Through Lean transformation and structured change management, advisors help operations and leadership teams align stakeholders, set daily and weekly governance cadences, and give frontline teams ownership of the redesign.

A recommendation to consolidate two distribution centers only works if the people running both sites understand why—and have a say in how it happens.

Data, Technology, and Scenario Modeling

Technology supports network decisions. It cannot fix bad data or an unclear objective. The stack that usually supports the work includes:

  • ERP and inventory planning systems
  • Transportation and warehouse management systems
  • Business intelligence platforms
  • Optimization software and digital twins

How the Models Actually Work

At its simplest, network models match supply and demand through feasible flows while checking costs, capacities, service requirements, inventory policies, and constraints against each other. Four related tools often get treated as interchangeable, but each answers a different question:

  • Optimization selects the best option among feasible decisions.
  • Simulation tests how a system behaves under uncertainty.
  • Forecasting estimates future demand or conditions.
  • Machine learning improves predictions or spots patterns in historical data.

A project might use forecasting to project demand, simulation to stress-test a scenario against volatility, and optimization to pick the best facility and flow configuration given both.

What Real Technology Impact Looks Like

Digital twins and simulation tools are showing measurable results in complex networks. BCG's 2024 case study of a steel manufacturer running 50 production assets, 300-plus warehouses, and more than 20,000 SKUs reported a 2-percentage-point EBITDA improvement and a 15% inventory reduction after simulating demand, supply, and production interdependencies up to 12 weeks ahead.

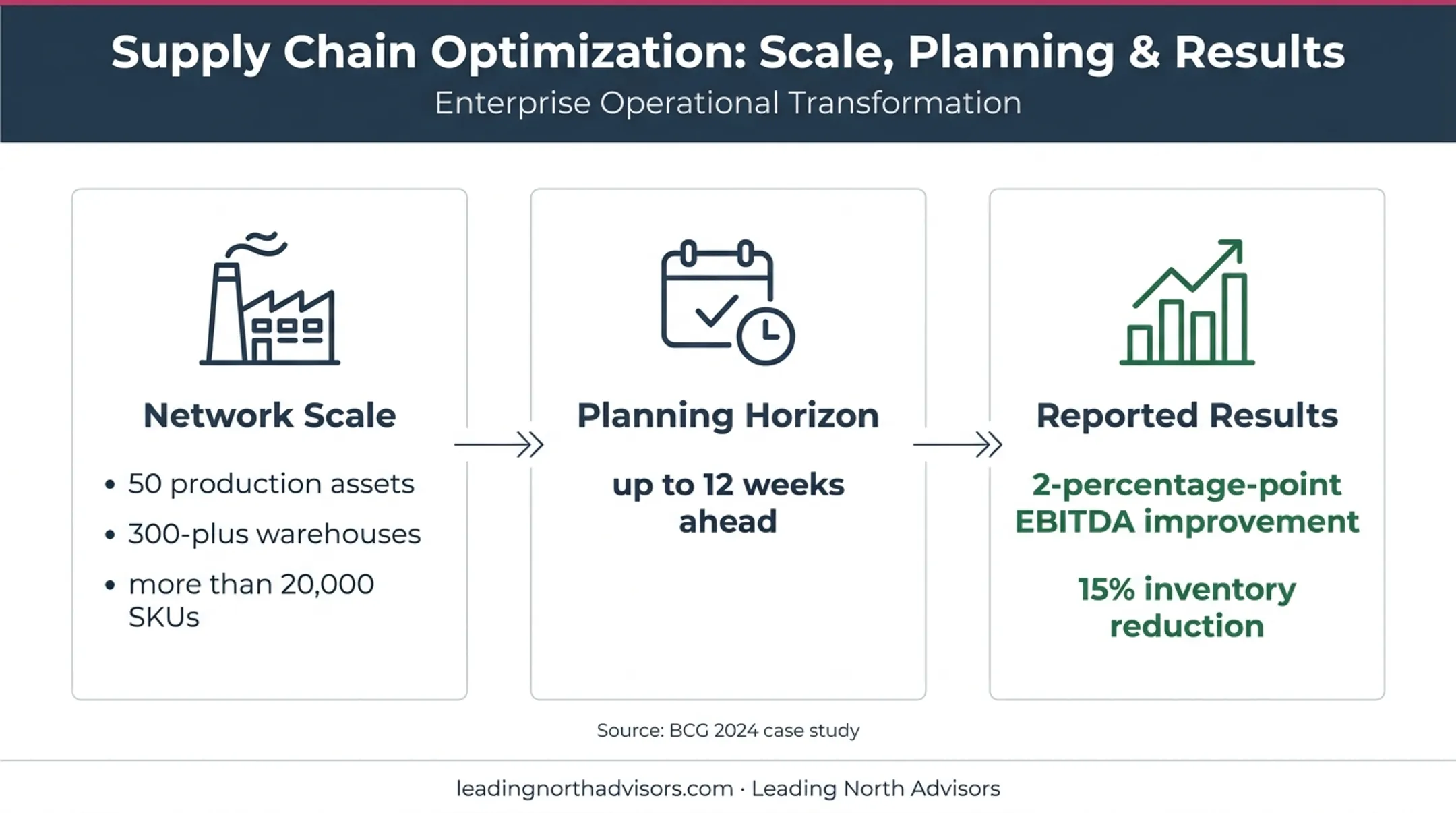

Digital twin supply chain case study results and network scale

Evaluating Software Without the Sales Pitch

Compare tools against your requirements, not brand recognition:

  • Which decisions does it actually support?
  • How well does it integrate with existing data sources?
  • Can it run multiple scenarios side by side and support sensitivity analysis?
  • Are its assumptions transparent, or is it a black box?
  • Will it scale as the network grows, and what do adoption and implementation support really require?

Start Strategic, Then Get Granular

A layered approach avoids over-engineering:

  1. Start with a strategic network view—where facilities should sit and how they should serve demand.
  2. Move next to tactical capacity and inventory decisions.
  3. Dig into detailed operational analysis only where it is actually needed.

Jumping straight to granular modeling before the strategic questions are settled usually wastes time.

How to Measure Network Optimization Success

A network redesign without a measurement plan is just an expensive opinion. KPIs should connect directly to the original business objective, not turn into a dashboard nobody reads.

Balanced KPI Categories

Group metrics so cost doesn't dominate every conversation:

  • Total landed cost and transportation cost
  • Inventory and working capital
  • On-time delivery and lead time
  • Fill rate and capacity utilization
  • Disruption exposure and emissions
  • Quality and workforce adoption

Set a baseline before the project starts. Without one, "improvement" is just a guess. Once that baseline is locked, the harder work is judging trade-offs the raw numbers alone won't settle.

Weighing Trade-Offs Honestly

Some of the best network decisions cost more upfront. Treat these trade-offs as deliberate choices, not failures of the model:

  • Accept a modest cost increase when it materially improves resilience
  • Hold extra inventory in volatile categories to protect service levels
  • Cut inventory only where the added risk stays inside what the business can tolerate

Track Implementation and Outcomes Together

Milestone completion and process adoption matter as much as the final numbers:

  • Milestone and go-live completion
  • Adoption of new processes on the floor
  • Realized savings against the business case
  • Service performance and inventory position
  • Changes in emergency interventions and expedites

A Real-World Example

Hain Celestial's network assessment, documented by NFI Industries, reviewed purchase orders, SKU inventory, inbound and outbound transportation, labor, and real estate across a network built through decades of acquisitions.

Results tied directly to those changes:

  • 11.7% lower transportation spend from carrier management and procurement
  • 3.4% further reduction from activity-based optimization
  • 43% increase in primary-carrier acceptance
  • 8% increase in on-time performance
  • 19% reduction in annual customer fines

Connect every KPI to a defined change in the network. If a metric can't trace back to a decision you made, drop it from the scorecard.

Hain Celestial network assessment results percentage improvement chart

Building Resilience and Sustainability Into the Network

Resilience and sustainability work best as design criteria, not add-ons bolted onto the cheapest network after the fact. A footprint optimized purely for cost usually has less capacity to absorb a shock.

Stress-Testing the Network

Scenario planning can test how a network holds up against:

  • Supplier failure or bankruptcy
  • Facility outages
  • Port or transportation interruptions
  • Sudden demand spikes
  • Labor shortages
  • Geopolitical shifts affecting trade or tariffs
  • Severe weather events

Resilience Choices Worth Modeling

A model can evaluate the cost and benefit of:

  • Alternate or dual sourcing
  • Regional production capacity
  • Strategic inventory buffers
  • Flexible transportation options
  • Postponement strategies
  • Backup facilities and defined recovery-time requirements

Each choice trades some efficiency for protection against disruption. The right mix depends on which risks the business actually can't absorb.

Where Sustainability Fits

Sustainability objectives belong in the same model. Build them in through:

  • Transportation distance and mode selection
  • Facility energy use
  • Packaging and waste
  • Emissions
  • Sourcing decisions

These choices sometimes conflict with pure cost or speed goals. A mode change might cut emissions but add a day to delivery.

The sequencing matters. Retrofitting resilience and sustainability onto a lowest-cost network almost always costs more than designing for them up front. Treat them as evaluation criteria alongside cost and service from the scenario-comparison step onward so every option stays on a level playing field.

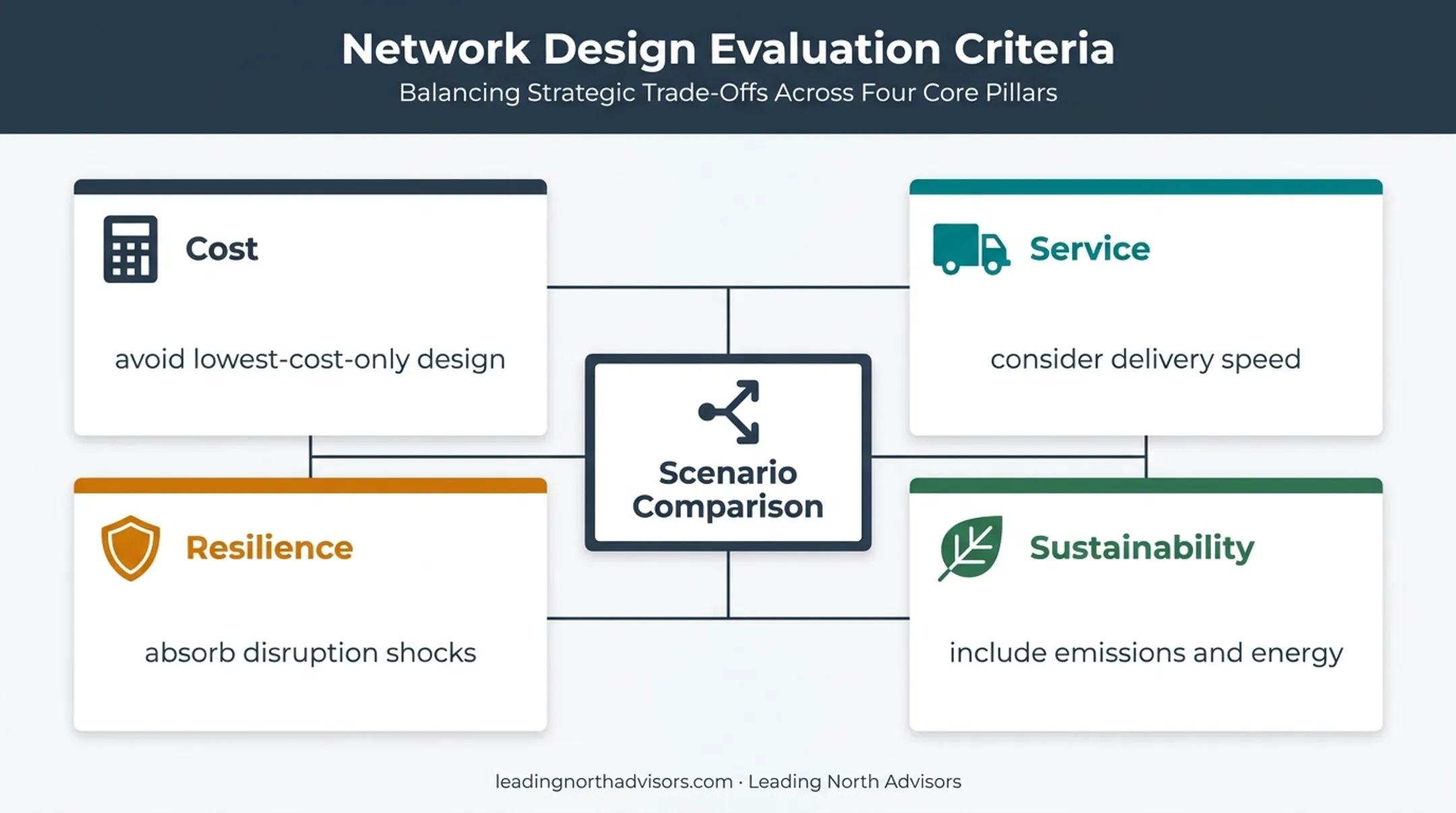

Supply chain network design criteria balancing cost service resilience sustainability

Make Network Optimization an Ongoing Management Capability

Network optimization gives supply chain leaders a structured way to make better interconnected decisions. Those decisions cover facilities, flows, inventory, capacity, service, risk, and sustainability—not one problem at a time.

Getting there requires a few consistent conditions:

  • Clear objectives
  • Trustworthy data
  • Realistic constraints
  • Honest scenario testing
  • Cross-functional ownership
  • Disciplined follow-through after the model is done

A well-designed network on paper doesn't guarantee results on the floor. That gap between recommendation and lasting performance is where continuous improvement and structured change management matter most.

Leading North Advisors helps operations and leadership teams close that gap through Lean transformation, cross-functional change management, and hands-on implementation support. If your organization is weighing a network redesign—or struggling to make a past one stick—reach out at info@leadingnorthadvisors.com to talk through what your team needs.

Frequently Asked Questions

What is the best software for supply chain network optimization?

The best software depends on your network's complexity, data environment, planning horizon, and integration needs. Compare tools against your documented business requirements, including scenario management and implementation support, before deciding.

What is network optimization?

Network optimization is the data-driven evaluation of facilities, suppliers, inventory, transportation, capacity, and demand to balance cost, service, and resilience. It is a structural design choice that shapes the supply chain over years, not a day-to-day operating tweak.

How long does a network optimization project take?

A full redesign typically runs 3 to 9 months depending on scope, data readiness, and how many facilities and regions are involved. A narrower diagnostic focused on one region or product line can move faster.

Do we need new software to start a network optimization project?

Not necessarily. Many organizations begin with existing ERP, transportation, and inventory data plus spreadsheet-based scenario modeling before investing in dedicated optimization software. The right tool depends on how complex the network becomes.

How often should a network be re-evaluated?

Set decision rules during the original project rather than waiting for a crisis. Most organizations revisit their network every 2 to 3 years, or sooner after a major acquisition, demand shift, or disruption.
